Contents

Executive Summary. 1

1    Introduction. 19

1.1     Project Background. 19

1.2     Project Organisation. 20

1.3     Construction Works Programme and Construction Works Area. 20

1.4     Summary of Environmental Status. 25

2    Air Quality Monitoring. 30

2.1     Monitoring Requirement. 30

2.2     Monitoring Location. 30

2.3     Monitoring Parameter and Frequency and Duration. 31

2.4     Monitoring Equipment. 31

2.5     Monitoring Methodology and QA/QC Procedure. 32

2.6     Action and Limit Level for Air Quality Monitoring. 35

2.7     Results and Observations. 36

2.8     Event and Action Plan. 37

3    Construction Noise Monitoring. 38

3.1     Monitoring Requirements. 38

3.2     Monitoring Locations. 38

3.3     Noise Monitoring Parameter, Frequency and Duration. 39

3.4     Monitoring Equipment, Methodology and QA / QC Procedure. 40

3.5     Maintenance and Calibration. 41

3.6     Action and Limit Levels. 41

3.7     Results and Observations. 42

3.8     Event and Action Plan. 43

4    Water Quality. 44

4.1     Monitoring Requirement. 44

4.2     Result and Observations. 44

5    Waste Management 45

6    Ecology. 46

6.1     Introduction. 46

6.2     Monitoring Requirements. 46

6.3     Results and Observations. 48

6.4     Man Kam To Road Egretry Monitoring. 59

6.5     Event and Action Plan. 59

7    Landscape and Visual 60

7.1     Audit Requirements. 60

7.2     Results and Observations. 60

7.3     Event and Action Plan. 60

8    Land Contamination (Ambient Arsenic Monitoring) 61

8.1     Monitoring Requirements. 61

8.2     Monitoring Locations. 61

8.3     Monitoring Equipment. 62

8.4     Monitoring Parameters, Frequency and Duration. 62

8.5     Monitoring Methodology and QA/QC Procedure. 63

8.6     Maintenance/Calibration. 64

8.7     Laboratory Measurement / Analysis. 64

8.8     Result and Observations. 65

8.9     Event and Action Plan. 65

9    Landfill Gas Monitoring. 66

9.1     Monitoring Requirements. 66

9.2     Monitoring Parameters and Frequency. 66

9.3     Monitoring Locations. 66

9.4     Result and Observations. 67

10     Built Heritage Monitoring. 68

10.1      Monitoring Requirements. 68

10.2      Monitoring Location. 68

10.3      Monitoring Parameters and Frequency. 68

10.4      Monitoring Equipment. 69

10.5      Result and Observations. 69

10.6      Event and Action Plan. 69

11     Environmental Site Inspection and Audit 71

11.1      Implementation Status of Environmental Mitigation Measures. 71

12     Summary of Monitoring Exceedance, Complaints, Notification of Summons and Prosecutions. 78

12.1      Summary of Exceedance. 78

12.2      Summary of Environmental Non-Compliance. 78

12.3      Summary of Environmental Complaint. 78

12.4      Summary of Environmental Summon and Successful Prosecution. 79

13     Future Key Issues. 80

13.1      Works and Potential Environmental Issues in the next Reporting Period. 80

13.2      Recommendation. 84

14     Conclusions. 87

14.1      Conclusion. 87

14.2      Comments/ Recommendations. 88







Figures

Figure 1.1        Location and Site Layout Plan (KTN)

Figure 1.2        Location and Site Layout Plan (FLN)

Figure 2.1        Location of Air Quality Monitoring Stations for KTN NDA

Figure 2.2        Location of Air Quality Monitoring Stations for FLN NDA

Figure 3.1        Location of Noise Monitoring Stations for KTN NDA

Figure 3.2        Location of Noise Monitoring Stations for FLN NDA

Figure 6.1        Transect Routes for Non-aquatic Fauna Monitoring of Measures to Minimise Impacts on Ecological Sensitive Habitats from Disturbance and Pollution (T1, T4 and T6), Aquatic Fauna Monitoring of Measures to Minimise Impacts to Ma Tso Lung Stream and Siu Hang San Tsuen Stream, and Long Valley (MS_01 - MS_10), and Waterbirds Monitoring of Measures to Minimise Disturbance to Waterbird (T3 and T5) for KTN NDA

Figure 6.2        Transect Routes for Non-aquatic Fauna Monitoring of Measures to Minimise Impacts on Ecological Sensitive Habitats from Disturbance and Pollution (T2 and T3), Aquatic Fauna Monitoring of Measures to Minimise Impacts to Ma Tso Lung Stream and Siu Hang San Tsuen Stream, and Long Valley (MS_11 - MS_15), and Waterbirds Monitoring of Measures to Minimise Disturbance to Waterbird (T1, T2 and T4) for FLN NDA

Figure 8.1        Location of Ambient Arsenic Monitoring Stations for KTN NDA



Appendices

Appendix 1.1    Construction Programme

Appendix 1.2    Project Organization Chart

Appendix 1.3    Implementation Status of Environmental Mitigation Measure

Appendix 2.1    Impact Monitoring Schedule during the reporting period

Appendix 2.2    Impact Air Quality Monitoring Data & Graphical Presentations & Calibration Certificates

Appendix 2.3    Weather Information during the Reporting Period

Appendix 2.4    Event and Action Plan for Construction Dust

Appendix 3.1    Impact Noise Monitoring Data & Graphical Presentations & Calibration Certificates

Appendix 3.2    Event and Action Plan for Construction Noise

Appendix 5.1    Summary of Monthly Waste Flow Table

Appendix 6.1    Detailed Results of the Ecological Waterbird Monitoring during this Reporting Period

Appendix 6.2    Detailed Results of the Ecological Aquatic Monitoring during this Reporting Period

Appendix 6.3    Detailed Results of the Ecological Non-aquatic Monitoring during this Reporting Period

Appendix 6.4    Event and Action Plan for Ecological Monitoring

Appendix 7.1    Event and Action Plan for Landscape and Visual

Appendix 8.1    Impact Ambient Arsenic Monitoring Data & Graphical Presentations &Calibration Certificates (sourced from the First Phase ET)

Appendix 8.2    Event and Action Plan for Ambient Arsenic Monitoring

Appendix 10.1   Location of Construction Vibration Monitoring

Appendix 10.2   Calibration Certificate for Vibration Monitoring Equipment

Appendix 10.3   Results for Vibration Monitoring

Appendix 12.1   Statistical Summary of Environmental Complaints, Summons and Prosecution

Appendix 13.1   Impact Monitoring Schedule of Next Reporting Month



Executive Summary

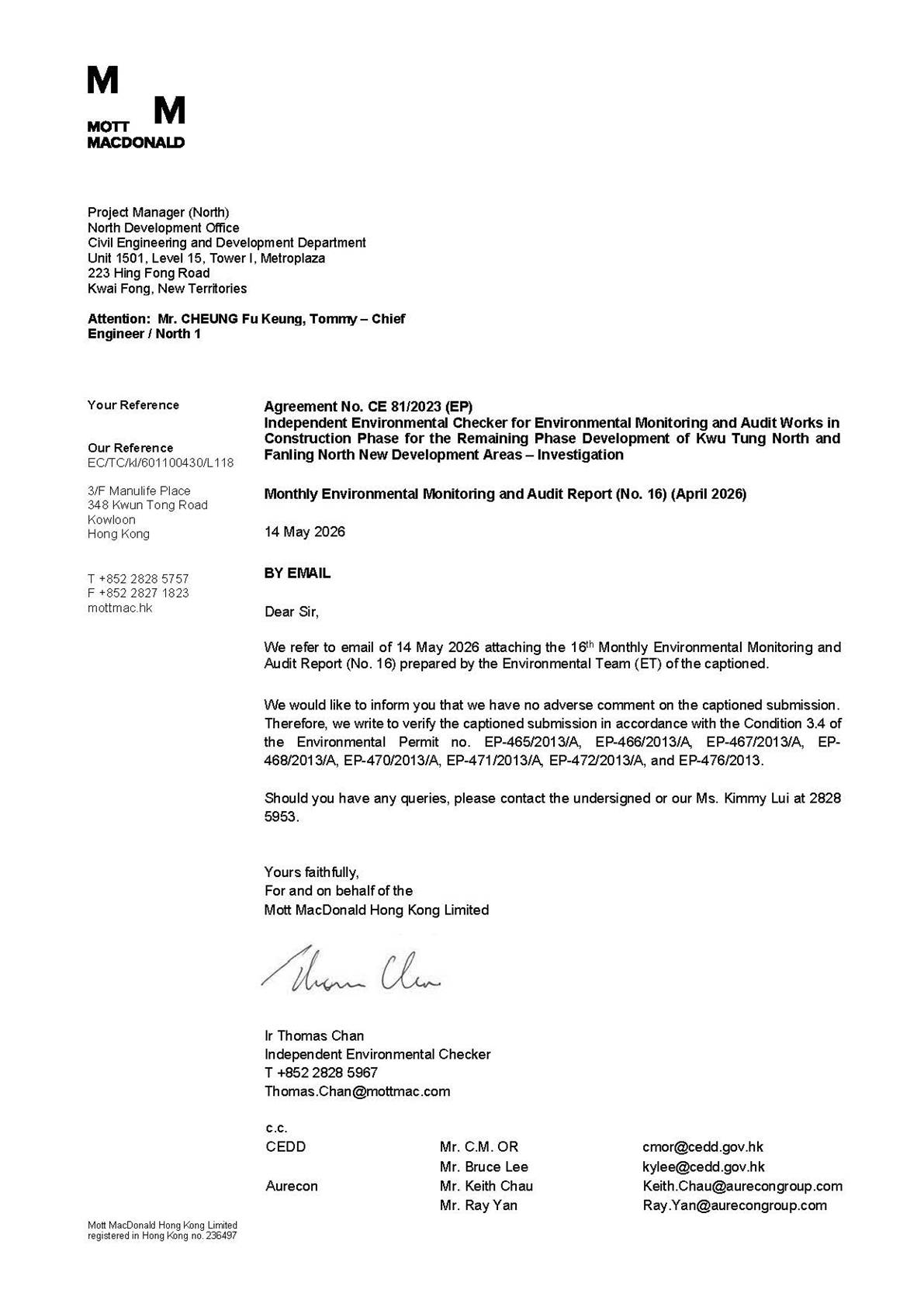

Introduction

A1.     This is the 16th Monthly Environment Monitoring and Audit (EM&A) Report for Remaining Phase Development of Kwu Tung North and Fanling North New Development Areas (the Project) for the reporting period between 1 and 30 April 2026. This report was prepared by Aurecon Hong Kong Limited (Aurecon) under Service Contract No. NDO 05/2024 Remaining Phase Development of Kwu Tung North and Fanling North New Development Areas - Environmental Team (hereinafter called the “Service Contract”).

A2.     Since only construction works were undertaken under Works Contract No. ND/2024/01, Works Contract No. ND/2024/02, Works Contract No. ND/2024/03, Works Contract No. ND/2024/04, Works Contract No. ND/2024/06 and Works Contract No. ND/2024/07 during the reporting month, this report documents the findings of EM&A works at Works Contract No.  ND/2024/01, Works Contract No. ND/2024/02, Works Contract No. ND/2024/03, Works Contract No.  ND/2024/04, Works Contract No. ND/2024/06 and Works Contract No. ND/2024/07 under the Project during the reporting period only. No construction works occurred in the remaining contracts during the reporting period for Works Contract ND/2024/05 and ND/2024/08.

A3.     This Project involves eight (8) Environmental Permits (EPs) (i.e. EP-465/2013/A, EP-466/2013/A, EP-467/2013/A, EP-468/2013/A, EP-470/2013/A, EP-471/2013/A, EP-472/2013/A and EP-476/2013). Details of each EPs are summarised in Table A1.

Table A1 Works Contracts under relevant Environmental Permits in the Reporting Month

Environmental Permit No.

Works Contracts

Title of Designated Project

Designated Project (DP)

EP-465/2013/A

ND/2024/03
ND/2024/04
ND/2024/05

San Tin Highway and Fanling Highway Kwu Tung Section Widening (Between San Tin Interchange and Po Shek Wu Interchange)

DP1

EP-466/2013/A

ND/2024/03
ND/2024/05

Castle Peak Road Diversion

DP2

EP-467/2013/A

ND/2024/01
ND/2024/02
ND/2024/03
ND/2024/05

Kwu Tung North New Development Area Road P1 and P2 and Associated New Kwu Tung Interchange and Pak Shek Au Interchange Improvement

DP3

EP-468/2013/A

ND/2024/01
ND/2024/02

Kwu Tung North New Development Area Road D1 to D5

DP4

EP-469/2013

-

Sewage Pumping Stations in Kwu Tung North New Development Area

DP5

EP-470/2013/A

ND/2024/06

Utilization of Treated Sewage Effluent (TSE) from Shek Wu Hui Sewage Treatment Works

DP7

EP-471/2013/A

ND/2024/04

Po Shek Wu Interchange Improvement

DP8

EP-472/2013/A

ND/2024/08

Fanling Bypass Western Section

DP9

EP-473/2013/A

-

Fanling Bypass Eastern Section

DP10

EP-474/2013

-

Shek Wu Hui Sewage Treatment Works - Further Expansion at Fanling North New Development Area

DP11

EP-476/2013

ND/2024/07

ND/2024/08

Sewage Pumping Stations in Fanling North New Development Area (FLNDA)

DP13

1.1.1.1      Key Construction Works in the Reporting Period

A4.     Apart from the construction works undertaken under Works Contract No. ND/2024/01 since 20 January 2025, construction works under Works Contract No. ND/2024/07 commenced since 27 February 2025, construction works under Works Contract No. ND/2024/06 commenced since 10 March 2025, construction works under Works Contract No. ND/2024/04 commenced since 10 May 2025, construction works under Works Contract No. ND/2024/03 commenced since 2 June 2025, construction works under Works Contract No. ND/2024/02 has also been commenced since 9 February 2026. No construction works occurred in the remaining Works Contracts (i.e. Works Contract ND/2024/05 and ND/2024/08) during the reporting period. The commencement dates of each Works Contracts are summarized in Table A2.

Table A2 Commencement Dates of Each Works Contracts

Works Contracts

Commencement Dates

ND/2024/01

20 January 2025

ND/2024/02

9 February 2026

ND/2024/03

2 June 2025

ND/2024/04

10 May 2025

ND/2024/05

11 May 2026

ND/2024/06

10 March 2025

ND/2024/07

27 February 2025

ND/2024/08

May 2026 (Tentatively)



A5.     A summary of construction activities undertaken during the reporting period is presented below:



Works Contract No. ND/2024/01:

·  All Site Resumption Area(s)

1.   Tree survey

2.   Site Clearance

·  Portion III (3), IV (4), V (5), VII (7) and XXXV (35)

1.   Site Formation

·  Portion XVIII (18), XXXVIII (38)

1.   Site Clearance

2.   Excavation Works

3.   Construction of CHC Box Culvert

·  Portion VI (6)

1.     Site Clearance

2.     Excavation Works

·  Portion VIII (8)

1.   Site Clearance & Demolition

2.   Asbestos Abatement Works

·  Portion XI (11), XXIII (23)

1.   Formwork Erection, Rebar Fixing, Concreting Works

·  Portion XII (12), XV (15), XXX (30), XXXI (31) and XLIV(44)

1.     Site Clearance

·  Portion XVI (16), XLII (42), LI (51) and LIII (53)

1.     Site Clearance and Demolition

·  Portion XL (40)

1.   Retaining Wall Construction

2.   Drainages System Construction

3.   ELS work

·  Portion LIX (59)

1.   Treatment of High Arsenic-Containing Soil (HAS)

·  Portion XVII (17), XVII (18), XXI (21), XXXIV (34), XXXV (35), XLI (41), XLII (42)

1.   Excavation works

2.   Drainage Pipe Installation

3.   ELS Works

·  Portion XXV (25), XXVII (27), XXXII (33) and XLII (42)

1.   Site Clearance

2.   Site Formation

3.   Construction of Box Culvert



Works Contract No. ND/2024/02:

·  Site clearance in Area A, B, C, D, T, L

·  Site formation works in Area D

·  Temporary storage fill bank in Kwu Tung Grass Soccer Pitch

·  Demolition works for Community Sports in Area J

·  Ground Investigation Works in Area B&L



Works Contract No. ND/2024/03:

        Fanling Highway & Castle Peak Road area



·  Pak Sau Road – Po Lau Road

1.   Tree Works

2.   Relocation/Reprovision/removal of existing TCSS, fire hydrant, signage & streetligting

·  Po Lau Road – Sheung Yue River

1.   Asbestos Removal Works at Portion IX

2.   Box Culvert Bay 37 – Bay 42 ELS

3.   Tree Works

·  TTA Stage 1 Works

1.   Tree Works

2.   Relocation/Reprovision/removal of existing TCSS, Fire Hydrant, Telecom post, High Voltage Post, Signage & Streetligting

New Tsung Pak Long Road



·  Box culvert Bay 10 to 12, 14 to 16 Drainage/Watermains

1.   Drainage, Sewerage & Watermain with Backfilling at Box Culvert Bay 15 & 16

2.   Box Culvert Bay 14 ELS

·  Box culvert Bay 17 to 19 & Drainage/Watermains

1.   Box Culvert Bay 17 to 19 ELS, Base Slab, Wall and Top Slab

2.   Box culvert Bay 17 & 19 Base Slab

·  Retaining Wall RW01

1.   Pre-drilling

·  Retaining Wall RW05A

1.   RW05A Bay 12, 14 & 16 Base Slab

2.   RW05A Bay 12, 14 & 16 Wall

·  Kwu Tung Road Bridge

1.   Site Clearance and Tree Works

2.   Site formation and cutback the existing slope

3.   Predrilling

4.   Foundation & Piling

·  Works Areas – WA1, WA2, WA3, WA4 & WA5

1.   Site Formation at PM’s Site Office

2.   Site Clearance, haul road and Temporary Drainage

3.   Asbestos removal

Fanling Highway Cross River Bridge (along Sheung Yue River)



·  Portion XI – East Abutment & pier foundation

1.   Trial Pits for UUs

2.   Piling Works

·  Road L3 Viaduct

1.   Piling Works

2.   Pile Cap L3A-02

·  Kwu Tung Interchange Foundation & Substructure - Bridge B1 & C1

1.   Piling Works

·  Widening of Existing Bridge No.N526

1.   Tree Works

2.   Pre-drilling

3.   Piling



Works Contract No. ND/2024/04:

·  Site Clearance

·  Site Establishment

·  Tree Felling

·  Trial Pit

·  Ground Investigation

·  Existing Sewage Diversion

·  Demolition of Existing Structures

·  Haul Road Construction

·  Bored Piling

·  ELS Construction

·  Slope Works



Works Contract No. ND/2024/06:

·  Portion A

1.   Excavation to +84 mPD of Portion A

2.   Carry Out Soil Nails of Portion A

·  Portion C, Portion E and Portion F

1.   Trench and Watermains Laying Works

·  Portion D

1.   Trench and Watermains Laying Works

2.   Demolition of DN2000  associated thrust blocks of Portion D

·  Pit B and Pit C

1.   Pre-boring



Works Contract No. ND/2024/07:

·  Area C

1.   Tree Felling

2.   Site Formation

·  Area D and Area E

1.   Site Formation

2.   Asbestos Removal

·  Area F

1.   Tree Felling

·  Area G

1.   Site Clearance

2.   Site Formation

3.   Asbestos Removal

·  Area H, Area I and Area R

1.   Asbestos Removal

·  Area J

1.   Road Construction

·  Area K

1.   Sewerage (DN1350) Construction

2.   Road Construction

3.   Site Clearance

·  Area O

1.   New Shrine Construction

·  Area P

1.   Site Formation

2.   Drainage Construction

·  Area Q

1.   Temporary Road Construction

2.   Drainage Construction

3.   Tree Transplant (2nd Pruning)

4.   Storm Pipe (DN1650) Construction

5.   Tree Felling

·  Portion 1b

1.   Assembly Yard for Bridge Construction

2.   Storage Yard for Concrete Pipe

·  Portion 3b

1.   Sewerage Construction

·  Portion 6c

1.   Improvement of Junction

·  Portion 9b

1.   Rebar Yard

·  Footbridge FB-4 (North)

1.   Lift Tower Construction

2.   ABWF Works

·  Footbridge FB-4 (South)

1.   Piling Works

2.   ABWF Works

·  Footbridge FB-5

1.   Pier Head Construction

2.   Lift Tower Construction

3.   Sump Pit Construction



Works Contract No. ND/2024/05 and ND/2024/08:

·  No construction work during the reporting period.

1.1.1.2      Environmental Monitoring and Audit Programme

A6.     The environmental monitoring activities, including 1-hour Total Suspended Particulates (TSP) monitoring, 24-hour TSP monitoring, noise monitoring, ecological survey, 24-hour Respirable Suspended Particulates (RSP) (Ambient Arsenic) monitoring for land contamination and environmental site inspection, were undertaken by Environmental Team (ET) under Service Contract No. NDO 04/2019 (i.e. First Phase ET – Wellab) and under Service Contract No. NDO 05/2024 (i.e. Remaining Phase ET - Aurecon) during the reporting period in accordance with the approved Updated EM&A Manual. A summary of the monitoring and audit activities during the reporting period is presented in Table A3.

Table A3 Summary of EM&A Activities in the Reporting Period

EM&A
 Activities

Monitoring Station(s)

Works Contract(s)(5)

ND/2024/01

ND/2024/02

ND/2024/03

ND/2024/04

ND/2024/05

ND/2024/06

ND/2024/07

ND/2024/08

1-hour TSP Monitoring(1)

KTN-DMS1(2)

N/A

N/A

N/A

N/A

N/A

N/A

N/A

N/A

KTN-DMS2(2)

N/A

N/A

N/A

N/A

N/A

N/A

N/A

N/A

KTN-DMS3(2)

N/A

N/A

N/A

N/A

N/A

N/A

N/A

N/A

KTN-DMS4(B)(2)(3)

6, 10, 16, 22, 28 April 2026

N/A

6, 10, 16, 22, 28 April 2026

N/A

N/A

N/A

N/A

N/A

FLN-DMS1(2)

N/A

N/A

N/A

N/A

N/A

N/A

1, 7, 13, 17, 23, 29 April 2026

N/A

FLN-DMS2(2)

N/A

N/A

N/A

N/A

N/A

N/A

N/A

N/A

FLN-DMS3(2)

N/A

N/A

N/A

N/A

N/A

N/A

N/A

N/A

FLN-DMS4(2)

N/A

N/A

N/A

N/A

N/A

N/A

N/A

N/A

FLN-DMS5(2)

N/A

N/A

N/A

N/A

N/A

N/A

6, 10, 16, 22, 28 April 2026

N/A

FLN-DMS6(A)(2)(3)

N/A

N/A

2, 8, 14, 20, 25, 30 April 2026(6)

N/A

N/A

N/A

N/A

FLN-DMS7(2)

N/A

N/A

N/A

N/A

N/A

N/A

N/A

N/A

24-hour TSP Monitoring(1)

KTN-DMS1(2)

N/A

N/A

N/A

N/A

N/A

N/A

N/A

N/A

KTN-DMS2(2)

N/A

N/A

N/A

N/A

N/A

N/A

N/A

N/A

KTN-DMS3(2)

N/A

N/A

N/A

N/A

N/A

N/A

N/A

N/A

KTN-DMS4(B)(2)(3)

6, 10, 16, 22, 28 April 2026

N/A

6, 10, 16, 22, 28 April 2026

N/A

N/A

N/A

N/A

N/A

FLN-DMS1(2)

N/A

N/A

N/A

N/A

N/A

N/A

6, 10, 16, 22, 28 April 2026

N/A

FLN-DMS2(2)

N/A

N/A

N/A

N/A

N/A

N/A

N/A

N/A

FLN-DMS3(2)

N/A

N/A

N/A

N/A

N/A

N/A

N/A

N/A

FLN-DMS4(2)

N/A

N/A

N/A

N/A

N/A

N/A

N/A

N/A

FLN-DMS5(A)(2)(3)

N/A

N/A

N/A

N/A

N/A

N/A

6, 10, 16, 22, 28 April 2026

N/A

FLN-DMS6(A)(2)(3)

N/A

N/A

2, 8, 14, 20, 25, 30 April 2026(6)

N/A

N/A

N/A

N/A

FLN-DMS7(2)

N/A

N/A

N/A

N/A

N/A

N/A

N/A

N/A

Noise Monitoring(1)

CP-KTN-NMS1(2)

2, 8, 14, 20, 30 April 2026(6)

2, 8, 14, 20, 30 April 2026(6)

N/A

N/A

N/A

N/A

N/A

N/A

CP-KTN-NMS2(2)

10, 16, 22, 28 April 2026

10, 16, 22, 28 April 2026

N/A

N/A

N/A

N/A

N/A

N/A

CP-KTN-NMS3(2)

10, 16, 22, 28 April 2026

10, 16, 22, 28 April 2026

N/A

N/A

N/A

N/A

N/A

N/A

CP-KTN-NMS4(2)

N/A

N/A

N/A

N/A

N/A

N/A

N/A

N/A

CP-KTN-NMS5(2)

N/A

N/A

N/A

N/A

N/A

10, 16, 22, 28 April 2026

N/A

N/A

CP-KTN-NMS6(2)

10, 16, 22, 28 April 2026

10, 16, 22, 28 April 2026

N/A

N/A

N/A

N/A

N/A

N/A

CP-KTN-NMS7(2)

2, 8, 14, 20, 30 April 2026(6)

2, 8, 14, 20, 30 April 2026(6)

N/A

N/A

N/A

N/A

N/A

N/A

CP-FLN-NMS1(2)

N/A

N/A

N/A

N/A

N/A

1, 10, 13, 23, 29 April 2026

N/A

CP-FLN-NMS3(2)

N/A

N/A

N/A

N/A

N/A

N/A

N/A

N/A

CP-FLN-NMS4(A)(2)(3)

N/A

N/A

N/A

9, 15, 21, 27 April 2026(6)

N/A

N/A

N/A

N/A

CP-FLN-NMS5(2)

N/A

N/A

N/A

N/A

N/A

N/A

9, 15, 21, 27 April 2026(6)

N/A

CP-FLN-NMS6(2)

N/A

N/A

N/A

N/A

N/A

N/A

9, 15, 21, 27 April  2026(6)

N/A

Ecological Monitoring (4)

Monitoring of Measures to Minimise Disturbance to Water Birds on Ng Tung River, Sheung Yue River, and Long Valley

Weekly Monitoring: 9, 10, 14, 17, 20, 23, 28, 30 April 2026 (Transect T1, T2, T3 and T5)


Additional Nighttime Monitoring at Long Valley:
20, 30
April 2026 (Transect T5)

Weekly Monitoring: 1, 8, 9, 10, 14, 16, 17, 20, 21, 22, 23, 28, 30 April 2026 (Transect T1, T2, T3, T4 and T5)


Additional Nighttime Monitoring at Long Valley:
20, 30
April 2026 (Transect T5)

Weekly Monitoring: 9, 10, 14, 17, 20, 23, 28, 30 April 2026 (Transect T1, T2, T3 and T5)


Additional Nighttime Monitoring at Long Valley:
20, 30
April 2026 (Transect T5)

Weekly Monitoring: 1, 8, 10, 14, 16, 21, 22, 28, 30 April 2026 (Transect T4)

N/A

Weekly Monitoring: 9, 10, 14, 17, 20, 23, 28, 30 April 2026 (Transect T1, T2 and T3)



Weekly Monitoring: 1, 8, 9, 10, 14, 16, 17, 20, 21, 22, 23, 28, 30 April 2026 (Transect T1, T2, T3 and T4)

Weekly Monitoring: 1, 8, 9, 10, 14, 16, 17, 20, 21, 22, 23, 28, 30 April 2026 (Transect T1, T2, T3 and T4)

Monitoring of Measures to Minimise Impacts to Ma Tso Lung Stream and Siu Hang San Tsuen Stream

Monthly Monitoring: 22 April 2026 (MS_01 – MS_10)

Monthly Monitoring: 22 April 2026 (MS_01 – MS_10)

N/A

N/A

N/A

N/A

Monthly Monitoring: 22 April 2026 (MS_11 – MS_15)

Monthly Monitoring: 22 April 2026 (MS_11 – MS_15)

Monitoring of Measures to Minimise Impacts on Ecological Sensitive Habitats from Disturbance and Pollution

Monthly Monitoring: 21 April 2026 (Transect T1)

Monthly Monitoring: 21 April 2026 (Transect T1 and T6)

Monthly Monitoring: 15 April 2026 (Transect T4)

N/A

N/A

Monthly Monitoring: 23, 27 April 2026 (Transect T2)

Monthly Monitoring: 15 April 2026 (Transect T3)

Monthly Monitoring: 15 April 2026 (Transect T3)

24-hour  RSP (Ambient Arsenic) Monitoring for Land Contamination (1)

KTN-DMS-4A(2)(3)

6, 10, 16, 22, 28 April 2026

N/A

6, 10, 16, 22, 28 April 2026

N/A

N/A

N/A

N/A

N/A

Water Quality Monitoring(1)

KTN-IS1

N/A

N/A

N/A

N/A

N/A

N/A

N/A

N/A

KTN-CS1

N/A

N/A

N/A

N/A

N/A

N/A

N/A

N/A

FLN-IS1

N/A

N/A

N/A

N/A

N/A

N/A

N/A

N/A

FLN-CS1

N/A

N/A

N/A

N/A

N/A

N/A

N/A

N/A

Landfill Gas Monitoring

250m Landfill Consultation Zone of Ma Tso Lung Landfill

N/A(7)

N/A(7)

N/A

N/A

N/A

N/A

N/A

N/A

Environmental Site Inspection

Site Area under Works Contract No. ND/2024/01

2, 9, 16, 21, 28 April 2026

N/A

N/A

N/A

N/A

N/A

N/A

N/A

Site Area under Works Contract No. ND/2024/02

N/A

2, 9, 17, 21, 28 April 2026

N/A

N/A

N/A

N/A

N/A

N/A

Site Area under Works Contract No. ND/2024/03

N/A

N/A

8, 15, 20, 27 April 2026

N/A

N/A

N/A

N/A

N/A

Site Area under Works Contract No. ND/2024/04

N/A

N/A

N/A

2, 10, 17, 24, 30 April 2026

N/A

N/A

N/A

N/A

Site Area under Works Contract No. ND/2024/06

N/A

N/A

N/A

N/A

N/A

9, 15, 21, 28 April 2026

N/A

N/A

Site Area under Works Contract No. ND/2024/07

N/A

N/A

N/A

N/A

N/A

N/A

2, 9, 16, 23, 30 April 2026

N/A



Remarks:

(1)       For 1-hour and 24-hour TSP & 24-hour RSP (Ambient Arsenic) monitoring, monitoring stations that are specifically within the 500m buffer area projected from the site boundary of works contract(s) will be considered being the representative monitoring stations for the corresponding works contract(s) and the associated impact monitoring exercises will be kicked off once the nearest works contracts have been commenced and undertaken during the reporting period/month.



For Noise Monitoring, monitoring stations that are specifically within the 300m buffer area projected from the site boundary of works contract(s) will be considered being the representative monitoring stations for the corresponding works contract(s) and the associated impact monitoring exercises will be kicked off once the nearest works contracts have been commenced and undertaken during the reporting period/month.



(2)       New monitoring station IDs are presented. The corresponding monitoring station IDs are as follows:

1-hour and 24-hour TSP / 24-hour RSP (Ambient Arsenic)

KTN-DMS1 = DMS1
KTN-DMS2 = DMS2
KTN-DMS3 = DMS3
KTN-DMS4(A)/4(B) = DMS4
FLN-DMS1 = DMS7
FLN-DMS2 = DMS9
FLN-DMS3 = DMS11
FLN-DMS4 = DMS6
FLN-DMS5/5(A) = DMS8
FLN-DMS6(A) = DMS10
FLN-DMS7 = DMS5

Noise

CP-KTN-NMS1 = CP-NMS1
CP-KTN-NMS2 = CP-NMS2
CP-KTN-NMS3 = CP-NMS3
CP-KTN-NMS4 = CP-NMS5
CP-KTN-NMS5 = CP-NMS7
CP-KTN-NMS6 = N/A

CP-KTN-NMS7 = CP-NMS4
CP-FLN-NMS1 = CP-NMS10
CP-FLN-NMS3 = CP-NMS12
CP-FLN-NMS4(A) = CP-NMS6
CP-FLN-NMS5 = CP-NMS8
CP-FLN-NMS6 = CP-NMS9



(3)       Alternative monitoring stations to the corresponding original monitoring stations.

(4)       The monitoring date for the reporting month was conducted by the ET from the First Phase of KTN/FLN NDAs Project, except Transect T4 for the ecological monitoring item Monitoring of Measures to Minimise Disturbance to Water Birds on Ng Tung River, Sheung Yue River, and Long Valley, and Transect T2 for the ecological monitoring item Monitoring of Measures to Minimise Impacts on Ecological Sensitive Habitats from Disturbance and Pollution. No ecological monitoring was conducted for the Monitoring of Measures to Minimise Impacts to Ma Tso Lung Stream and Siu Hang San Tsuen Stream for this reporting month as this monitoring is only conducted during wet season (April – October). Detailed divisions of work between First Phase ET and Remaining Phase can be referred to Section 6 and relevant appendix.

(5)       N/A – No relevant monitoring is required according to the approved updated EM&A Manual.

(6)       The monitoring date for the reporting month was conducted by the ET from the Remaining Phase of KTN/FLN NDAs Project.

(7)       As confirmed by the Supervisor Team, no ground disturbance works were carried out in the work area within 250m Landfill Consultation Zone of Ma Tso Lung Landfill including construction of the infrastructure, development works, excavation works and works involve confined spaces. Routine gas monitoring should be undertaken during groundwork construction and in all excavations.



1.1.1.3      Breaches of Action Levels (AL) and Limit Levels (LL)

A7.     Summary of the environmental exceedances of the reporting period is tabulated in Table A4.

Table A4 Summary of Exceedances in the Reporting Period

Environmental Monitoring

Parameter(s)

No. of Exceedances

Total No. of Exceedances

No. of Non-project Related Exceedances

Total No. of Non-project Related Exceedances

No. of Exceedances

Related to the Project

Total No. of Exceedances

Related to the Project

AL

LL

AL

LL

AL

LL

Air Quality

1-hour TSP

0

0

0

0

0

0

0

0

0

24-hourTSP

0

0

0

0

0

0

0

0

0

24-hour RSP

(Ambient Arsenic)

0

0

0

0

0

0

0

0

0

Noise

Leq(30mins)

3

0

3

3

0

3

0

0

0

Ecological Monitoring

Avifauna

0

0

0

0

0

0

0

0

0

Non-aquatic fauna

0

0

0

0

0

0

0

0

0



Air Quality

A8.     No AL or LL exceedance was recorded for air quality monitoring in the reporting period.

Noise

A9.     Three AL exceedances for construction noise were recorded during the reporting month, corresponding to three noise-related complaints received. No LL exceedance was recorded for construction noise monitoring in the reporting period.

Ambient Arsenic

A10.  No AL or LL exceedance was recorded for ambient arsenic monitoring in the reporting period.



Ecological Monitoring

A11.  No AL or LL exceedance was recorded for ecological monitoring in the reporting period.



Built Heritage Monitoring (Vibration Monitoring)

A12.  No exceedance of limits was recorded for vibration monitoring in the reporting period.

1.1.1.4      Complaint Log

A13.  Total of 5 complaints were received during the reporting period.

A14.  The first environmental complaint was related to construction dust and construction waste generated from FLN NDA construction sites, particularly at Ma Sik Road on 8 April 2026 under works contract ND/2024/07. The complaint was received by EPD on 8 April 2026 and referred to CEDD, ET and IEC on 15 April 2026. The complaint case has been investigated by the Contractor and ET, and the investigation was closed out on 22 April 2026. The investigation findings indicate that there was no non-compliance by the contractor.

A15.  The second environmental complaint was related to construction noise generated from FLN NDA construction sites, particularly at Po Shek Wu Road North Bound near Tai Tau Leng Village Vehicular Access on 22 April 2026 under works contract ND/2024/04. The complaint was received by 1823 on 22 April 2026 and referred to CEDD, ET and IEC on 24 April 2026. The complaint case has been investigated by the Contractor and ET, and the investigation was closed out on 03 May 2026. The investigation findings indicate no non-compliance on conditions stipulated on the valid Construction Noise Permit (CNP).

A16.  The third environmental complaint was related to construction noise generated from FLN NDA construction sites, particularly at Po Shek Wu Road North Bound near Tai Tau Leng Village Vehicular Access on 22 April 2026 under works contract ND/2024/04. The complaint was received by 1823 on 22 April 2026 and referred to CEDD, ET and IEC on 24 April 2026. The complaint case has been investigated by the Contractor and ET, and the investigation was closed out on 03 May 2026. The investigation findings indicate no non-compliance on conditions stipulated on the valid Construction Noise Permit (CNP).

A17.  The fourth environmental complaint was related to construction dust and noise generated from KTN construction sites, particularly at Kwu Tung Yin Liu on 28 April 2026 under works contract ND/2024/03. The complaint was received by EPD on 28 April 2026 and referred to CEDD, ET and IEC on 28 April 2026. The complaint case has been investigated by the Contractor and ET, and the investigation was closed out on 11 May 2026.  The investigation findings indicate that the complaint was not project related.

A18.  The fifth complaint was related to sand and muddy water deposited on the carriageway caused by KTN construction sites, particularly at Castle Peak Road between Sheung Pak Nai Sewage Pumping Station and Pak Sau Road on 25 April 2026 under works contract ND/2024/03. The complaint was received by EPD on 25 April 2026 and referred to CEDD, ET and IEC on 29 April 2026. The complaint case has been investigated by the Contractor and ET, and the investigation was closed out on 11 May 2026. The investigation findings indicate that there was no non-compliance by the contractor.

A19.  The details of the complaints and investigation results are shown in Appendix 12.1.

1.1.1.5      Notification of Summons and Successful Prosecutions

A20.  No notification of summons or successful prosecutions was received in the reporting period.

1.1.1.6      Reporting Changes

A21.  There was no change to be reported that may affect the on-going EM&A programme.

1.1.1.7      Future Key Issues

A22.  The major site activities for the next reporting period are summarized below and shown in Appendix 1.1:



Works Contract No. ND/2024/01:

·  All Site Resumption Area(s)

1.   Tree survey

2.   Site Clearance

·  Portion III (3), IV (4), V (5) and XXXV (35)

1.   Site Formation

·  Portion VIII (8), XVI (16), XXXII (31) and LVIII (58)

1.     Site Clearance & Demolition

·  Portion XVIII (18), XXXVIII (38)

1.     Excavation works

2.     Construction of CHC Box Culvert

·  Portion XI (11), XXIII (23)

1.     Formwork Erection, Rebar Fixing, Concreting Works

2.     Erection of Substructure of Metropolis Community Liaison and Visitor Centre

·  Portion XL (40)

1.   Retaining Wall Construction

2.   Drainages System Construction

3.   ELS work

·  Portion LIX (59)

1.   Treatment of High Arsenic-Containing Soil (HAS)

2.   Erection of Shredding Facility

·  Portion XVII (17), XVII (18), XXI (21), XXXIV (34), XXXV (35), XLI (41), XLII (42)

1.   Excavation Works

2.   Drainage Pipe Installation

3.   ELS Works

·  Portion XXV (25), XXVII (27), XXXIII (33), XLII (42) and XLIV (44)

1.   Site Clearance

2.   Site Formation

3.   Construction of Box Culvert



Works Contract No. ND/2024/02:

1.    Site clearance in Area A, B, C, D, T, L

2.    Site formation works in Area D

3.   Temporary storage fill bank in Kwu Tung Grass Soccer Pitch

4.    Demolition works for Community Sports in Area J

5.   Ground Investigation Works in Area B & L

6.   Asbestos Removal Works in Area C



Works Contract No. ND/2024/03:

Fanling Highway & Castle Peak Road area



·  Pak Sau Road – Po Lau Road

1.   Relocation/Reprovision/Removal of Existing TCSS, Fire Hydrant, Signage & Streetlighting

2.   Tree Works

·  Po Lau Road – Sheung Yue River

1.   Asbestos Removal Works at Portion IX

2.   Box Culvert Bay 37 – Bay 42 ELS

·  TTA Stage 1 Works

1.   Tree Works

2.   Removal or relocation of directly impacted Shrine/historical building at HKT08 & KT72

3.   Demolish of Central Divider & Barrier along FL Highway E/B

New Tsung Pak Long Road



·  Box culvert Bay 10 to 12, 14 to 16 Drainage/Watermains

1.   Drainage, Sewerage & Watermain with Backfilling at Box Culvert Bay 15 & 16

2.   Box Culvert Bay 10-13 & 14 ELS

3.   Removal of ELS and Temp Road Diversion

·  Box culvert Bay 17 to 19 & Drainage/Watermains

1.   Box Culvert Bay 17 to 19 ELS, Base Slab, Wall and Top Slab

·  TTA Stage 1B

1.   Box Culvert Bay 3, 5 to 7, 7A ELS

2.   Box Culvert Base Slab

·  Retaining Wall RW05A

1.   RW05A ELS

2.   Base Slab and Wall

·  Kwu Tung Road Bridge

1.   Site Clearance and Tree Works

2.   Site formation and cutback the existing slope

3.   Foundation & Piling

·  Works Areas – WA1, WA2, WA3, WA4 & WA5

1.   Temporary Drainage

2.   Asbestos removal

Fanling Highway Cross River Bridge (along Sheung Yue River)



·  Portion XI – East Abutment & pier foundation (No works at wet season between 1 Apr 2026 and 31 Oct 2026)

1.   Trial Pits for UUs

2.   Piling Works

·  Road L3 Viaduct

1.   Piling Works

2.   Pile Cap L3A-02

Kwu Tung Interchange Foundation & Substructure



·  Bridge B1 & C1

1.   Piling Works

2.   ELS

·  Bridge B2 & C2

1.   Piling Work

·  Footbridges No. 4 at TTA Stage 1

1.   Ground Investigation

2.   Underground Utilities Works

3.   Piling

·  Footbridges No. 5 at TTA Stage 2

1.   Predrilling

·  Widening of Existing Bridge No.N526

1.   Tree Works

2.   Pilling



Works Contract No. ND/2024/04:

1.   Site Clearance

2.   Site Establishment

3.   Tree Felling

4.   Trial Pit

5.   Existing Sewage Diversion

6.   Haul Road Construction

7.   Bored Piling

8.   ELS Construction

9.   Slope Works

10.Road Diversion Works

11.Demolition of Existing Structures



Works Contract No. ND/2024/06:

·  Portion A

1.   Excavation to +84 mPD of Portion A

2.   Carry Out Soil Nail of Portion A

·  Portion C, D, E & F

1.     Trench and Watermans Laying Works

·  Area N

1.   Jacking Pit Excavation

·  Pre-boring of Pit B & C



Works Contract No. ND/2024/07:

1.   Site Clearance

2.   Site Formation

3.   Ground Investigation

4.   Pre-bored Socketed H Pile Construction

5.   Bridge Construction

6.   Bridge Deck Connection (Footbridge FB5)

7.   Lift Tower Construction

8.   Sump Pit Construction

9.   ABWF Works

10.Drainage Construction

11.Improvement of Junction

12.Road Construction

13.Temporary Road Construction

14.Open Landscaping Works

15.Tree Felling & Transplantation

16.Asbestos Containing Materials Survey & Removal

17.Land Contamination (Environmental Ground Investigation)

18.Internal Movement, Importation & Exportation of C&D materials

19.Sewerage Construction

20. Old Shrine Removal and New Shrine Construction

21. Storm pipe Construction

22. Box Culvert Construction

23.Temporary Drainage Diversion

24. Rebar Yard

25.Storage Yard for Concrete Pipe



Works Contract No. ND/2024/05 and ND/2024/08:

1.   The construction work has not commenced in the reporting month.





1              Introduction

1.1          Project Background

1.1.1       The Kwu Tung North and Fanling North New Development Areas (KTN and FLN NDAs) development are implemented in two phases, comprising First Phase and Remaining Phase developments.  The construction works for the First Phase development commenced in December 2019. The construction works for the Remaining Phase development (the Project), including site clearance and formation, roads, drainage, sewerage and water supply systems, commenced progressively from the January 2025.

1.1.2       The Project is delivered under eight (8) Works Contracts as below.

·     Contract No. ND/2024/01: Site Formation and Infrastructure Works (South);

·     Contract No. ND/2024/02: Site Formation and Infrastructure Works (North);

·     Contract No. ND/2024/03: Improvement Works of Fanling Highway (Kwu Tung Portion) and Associated Works;

·     Contract No. ND/2024/04: Improvement Works of Tai Tau Leng Roundabout and Po Shek Wu Road and Associated Works;

·     Contract No. ND/2024/05: Improvement Works of Fanling Highway (Pak Shek Au Portion) and Associated Works;

·     Contract No. ND/2024/06: Fresh Water and Flushing Water Service Reservoirs and Associated Works;

·     Contract No. ND/2024/07: Site Formation and Infrastructure Works (East); and

·     Contract No. ND/2024/08: Site Formation and Infrastructure Works (West).

1.1.3       The EIA Report (AEIAR-175/2013) for NENT NDA was approved with conditions under EIAO in 2013. The Environmental Permits for corresponding Designated Projects were also issued by DEP in November 2013. Subsequent to the findings of preliminary design and P&E Review for accommodating additional population in KTN and FLN NDAs, VEP were subsequently applied for eight EPs under the Project (i.e. EP-465/2013/A, EP-466/2013/A, EP-467/2013/A, EP-468/2013/A, EP-470/2013/A, EP-471/2013/A, EP-472/2013/A and EP-476/2013).

1.1.4       Aurecon was commissioned by Civil Engineering and Development Department (CEDD) to provide EM&A services for the works contracts in relation to the Project pursuant to the requirements as specified in relevant EPs, the EM&A Manual issued in the EIA stage, the Updated EM&A Manual prepared for Contract No. NDO 14/2018 and the approved EIA Report for the Project to discharge the duties of the ET for the Project.

1.1.5       This is the 16th Monthly EM&A Report summarizing the findings of EM&A works at Works Contract No. ND/2024/01 under the Project with EP-467/2013/A and EP-468/2013/A, Works Contract No. ND/2024/02 under the Project with EP-467/2013/A and EP-468/2013/A, Works Contract No. ND/2024/03 under the Project with EP-465/2013/A, EP-466/2013/A and EP-467/2023/A, Works Contract No. ND/2024/04 under the Project with EP-465/2013/A and EP-471/2013/A, Works Contract No. ND/2024/06 under Environmental Permit No. EP-470/2013/A and for Contract No. ND/2024/07 under Environmental Permit No. EP-476/2013 during the reporting period from 1 to 30 April 2026. No construction works occur in the remaining contracts during the reporting period for Contract No. ND/2024/05 and ND/2024/08.

1.2          Project Organisation

1.2.1       Parties with different levels of involvement in the Project organisation for Works Contracts are summarized in Table 1.1.

Table 1.1 Parties Involved in Project Organization for all Works Contracts



Works Contract(s)

Parties

ND/2024/01

ND/2024/02

ND/2024/03

ND/2024/04

ND/2024/05

ND/2024/06

ND/2024/07

ND/2024/08

Project Proponent

CEDD

Supervisor / Engineer’s Representative (ER)

AECOM Asia Co. Ltd.

AECOM Asia Co. Ltd.

AECOM Asia Co. Ltd

AECOM Asia Co. Ltd

AECOM Asia Co. Ltd

Binnies Hong Kong Limited

AtkinsRéalis

AtkinsRéalis

Contractor

Build King - Richwell Engineering Joint Venture

Build King – Richwell Civil Joint Venture



China State - STEC Joint Venture

CW – CRCC (ND202404) Joint Venture

Lanon – Sinohydro – Excel JV

Wo Hing-Tsun Yip Joint Venture

Build King – Richwell Civil Joint Venture

Gammon - STEC Joint Venture

ET

Aurecon Hong Kong Limited

Independent Environmental Checker (IEC)

Mott MacDonald Hong Kong Limited

1.2.2       The key personnel contact names and contact numbers are summarized in Appendix 1.2.

1.3          Construction Works Programme and Construction Works Area

1.3.1       The construction phase EM&A programme commenced since 20 January 2025 progressively. The construction works programme, and the construction works area of the Project are shown in Appendix 1.1 and Figure 1.1 respectively. A summary of construction activities undertaken during the reporting period is presented below:



Works Contract No. ND/2024/01:

·  All Site Resumption Area(s)

1.   Tree survey

2.   Site Clearance

·  Portion III (3), IV (4), V (5), VII (7) and XXXV (35)

1.   Site Formation

·  Portion XVIII (18), XXXVIII (38)

1.   Site Clearance

2.   Excavation Works

3.   Construction of CHC Box Culvert

·  Portion VI (6)

1.   Site Clearance

2.   Excavation Works

·  Portion VIII (8)

1.   Site Clearance & Demolition

2.   Asbestos Abatement Works

·  Portion XI (11), XXIII (23)

1.   Formwork Erection, Rebar Fixing, Concreting Works

·  Portion XII (12), XV (15), XXX (30), XXXI (31) and XLIV(44)

1.   Site Clearance

·  Portion XVI (16), XLII (42), LI (51) and LIII (53)

1.   Site Clearance and Demolition

·  Portion XL (40)

1.   Retaining Wall Construction

2.   Drainages System Construction

3.   ELS work

·  Portion LIX (59)

1.   Treatment of High Arsenic-Containing Soil (HAS)

·  Portion XVII (17), XVII (18), XXI (21), XXXIV (34), XXXV (35), XLI (41), XLII (42)

1.   Excavation works

2.   Drainage Pipe Installation

3.   ELS Works

·  Portion XXV (25), XXVII (27), XXXII (33) and XLII (42)

1.   Site Clearance

2.   Site Formation

3.   Construction of Box Culvert

Works Contract No. ND/2024/02:

·  Site clearance in Area A, B, C, D, T, L

·  Site formation works in Area D

·  Temporary storage fill bank in Kwu Tung Grass Soccer Pitch

·  Demolition works for Community Sports in Area J

·  Ground Investigation Works in Area B & L



Works Contract No. ND/2024/03:

        Fanling Highway & Castle Peak Road area



·  Pak Sau Road – Po Lau Road

1.   Tree Works

2.   Relocation/Reprovision/removal of existing TCSS, fire hydrant, signage & streetligting

·  Po Lau Road – Sheung Yue River

1.   Asbestos Removal Works at Portion IX

2.   Box Culvert Bay 37 – Bay 42 ELS

3.   Tree Works

·  TTA Stage 1 Works

1.   Tree Works

2.   Relocation/Reprovision/removal of existing TCSS, Fire Hydrant, Telecom post, High Voltage Post, Signage & Streetligting

New Tsung Pak Long Road



1.   Box culvert Bay 10 to 12, 14 to 16 Drainage/Watermains

2.   Drainage, Sewerage & Watermain with Backfilling at Box Culvert Bay 15 & 16

3.   Box Culvert Bay 14 ELS

·  Box culvert Bay 17 to 19 & Drainage/Watermains

1.   Box Culvert Bay 17 to 19 ELS, Base Slab, Wall and Top Slab

2.   Box culvert Bay 17 & 19 Base Slab

·  Retaining Wall RW01

1.   Pre-drilling

·  Retaining Wall RW05A

1.   RW05A Bay 12, 14 & 16 Base Slab

2.   RW05A Bay 12, 14 & 16 Wall

·  Kwu Tung Road Bridge

1.   Site Clearance and Tree Works

2.   Site formation and cutback the existing slope

3.   Predrilling

4.   Foundation & Piling

·  Works Areas – WA1, WA2, WA3, WA4 & WA5

1.   Site Formation at PM’s Site Office

2.   Site Clearance, haul road and Temporary Drainage

3.   Asbestos removal

Fanling Highway Cross River Bridge (along Sheung Yue River)



·  Portion XI – East Abutment & pier foundation

1.   Trial Pits for UUs

2.   Piling Works

·  Road L3 Viaduct

1.   Piling Works

2.   Pile Cap L3A-02

·  Kwu Tung Interchange Foundation & Substructure - Bridge B1 & C1

1.   Piling Works

·  Widening of Existing Bridge No.N526

1.   Tree Works

2.   Pre-drilling

3.   Piling



Works Contract No. ND/2024/04:

·  Site Clearance

·  Site Establishment

·  Tree Felling

·  Trial Pit

·  Ground Investigation

·  Existing Sewage Diversion

·  Demolition of Existing Structures

·  Haul Road Construction

·  Bored Piling

·  ELS Construction

·  Slope Works



Works Contract No. ND/2024/06:

·  Portion A

1.   Excavation to +84 mPD of Portion A

2.   Carry Out Soil Nail of Portion A

·  Portion C, Portion D, Portion E and Portion F

1.   Trench and Watermains Laying Works

·  Portion D

1.   Trench and Watermains Laying Works

2.   Demolition of DN2000  Associated Thrust Blocks of Portion D

·  Pit B and Pit C

1.   Pre-boring



Works Contract No. ND/2024/07:

·  Area C

1.   Tree Felling

2.   Site Formation

·  Area D and Area E

1.   Site Formation

2.   Asbestos Removal

·  Area F

1.   Tree Felling

·  Area G

1.   Site Clearance

2.   Site Formation

3.   Asbestos Removal

·  Area H, Area I and Area R

1.   Asbestos Removal

·  Area J

1.   Road Construction

·  Area K

1.   Sewerage (DN1350) Construction

2.   Road Construction

3.   Site Clearance

·  Area O

1.   New Shrine Construction

·  Area P

1.   Site Formation

2.   Drainage Construction

·  Area Q

1.   Temporary Road Construction

2.   Drainage Construction

3.   Tree Transplant (2nd Pruning)

4.   Storm Pipe (DN1650) Construction

5.   Tree Felling

·  Portion 1b

1.   Assembly Yard for Bridge Construction

2.   Storage Yard for Concrete Pipe

·  Portion 3b

1.   Sewerage Construction

·  Portion 6c

1.   Improvement of Junction

·  Portion 9b

1.   Rebar Yard

·  Footbridge FB-4 (North)

1.   Lift Tower Construction

2.   ABWF Works

·  Footbridge FB-4 (South)

1.   Piling Works

2.   ABWF Works

·  Footbridge FB-5

1.   Pier Head Construction

2.   Lift Tower Construction

3.   Sump Pit Construction



Works Contract No. ND/2024/05 and ND/2024/08:

·  No construction work during the reporting period.

1.4          Summary of Environmental Status

1.4.1       A summary of the relevant permits, licences, and/or notifications on environmental protection for the work contracts that are involved in this reporting period is presented in Table 1.2 to Table 1.7.





Table 1.2 Status of Environmental License, Notifications and Permits for Works Contract No. ND/2024/01

Permit / License Name/No.

Valid Period

Status

From

To

Environmental Permit

EP-467/2013/A

27/01/2017

N/A

Valid

EP-468/2013/A

27/01/2017

N/A

Valid

Notification pursuant to Air Pollution Control (Construction Dust) Regulation

10008709

02/09/2024

N/A

Valid

Billing Account for Disposal of Construction Waste

7052236

20/09/2024

N/A

Valid

Registration of Chemical Waste Producer

WPN: 5213-548-B2781-01

06/12/2024

N/A

Valid

Effluent Discharge License under Water Pollution Control Ordinance

WT00045924-2024

15/01/2025

31/01/2030

Valid

WT00046627-2025

03/06/2025

30/06/2030

Valid

WT00046736-2025

10/06/2025

30/06/2030

Valid

WT00046982-2025

03/10/2025

31/10/2030

Valid

WT00047583-2025

19/01/2026

31/01/2031

Valid

WT00048070-2025

28/01/2026

31/01/2031

Valid

WT00048369-2026

14/04/2026

30/04/2031

Valid

Construction Noise Permit (CNP)







GW-RN0390-26

26/03/2026

25/07/2026

Valid

GW-RN1593-25

04/01/2026

30/06/2026

Valid

GW-RN0041-26

16/01/2026

15/04/2026

Valid until 15/04/2026

GW-RN0254-26

27/02/2026

26/05/2026

Valid

GW-RN0166-26

08/02/2026

07/05/2026

Valid

GW-RN0512-26

20/04/2026

19/07/2026

Valid



Table 1.3 Status of Environmental License, Notifications and Permits for Works Contract No. ND/2024/02

Permit / License Name/No.

Valid Period

Status

From

To

Environmental Permit

EP-467/2013/A

27/01/2017

N/A

Valid

EP-468/2013/A

27/01/2017

N/A

Valid

Notification pursuant to Air Pollution Control (Construction Dust) Regulation

10024940

23/12/2025

N/A

Valid

Billing Account for Disposal of Construction Waste

7057203

05/01/2026

N/A

Valid

Registration of Chemical Waste Producer

WPN:5213-545-B2803-01

11/02/2026

N/A

Valid

Effluent Discharge License under Water Pollution Control Ordinance

WT00048304-2026

18/03/2026

31/03/2031

Valid

Application Ref. No.10027555

Applied on 11/03/2026

N/A

Under application

Construction Noise Permit (CNP)







Application Ref. No.10029112

Applied on 20/04/2026

N/A

Under application





Table 1.4 Status of Environmental License, Notifications and Permits for Works Contract No. ND/2024/03

Permit / License Name/No.

Valid Period

Status

From

To

Environmental Permit

EP-465/2013/A

20/01/2017

N/A

Valid

EP-466/2013/A

18/08/2022

N/A

Valid

EP-467/2013/A

27/01/2017

N/A

Valid

Notification pursuant to Air Pollution Control (Construction Dust) Regulation

10008101

15/08/2024

N/A

Valid

Billing Account for Disposal of Construction Waste

7052008

21/08/2024

N/A

Valid

Registration of Chemical Waste Producer

WPN:5213-548-C5047-01

22/01/2025

N/A

Valid

Effluent Discharge License under Water Pollution Control Ordinance

WT00046044-2025

07/11/2025

28/02/2030

Valid

Construction Noise Permit (CNP)







GW-RN0243-26

19/03/2026

18/06/2026

Valid

GW-RN0398-26

03/04/2026

02/07/2026

Valid



Table 1.5 Status of Environmental License, Notifications and Permits for Works Contract No. ND/2024/04

Permit / License Name/No.

Valid Period

Status

From

To

Environmental Permit

EP-465/2013/A

20/01/2017

N/A

Valid

EP-471/2013/A

10/10/2022

N/A

Valid

Notification pursuant to Air Pollution Control (Construction Dust) Regulation

10012919

06/01/2025

N/A

Valid

Billing Account for Disposal of Construction Waste

7053746

13/02/2025

N/A

Valid

Registration of Chemical Waste Producer

WPN:5213-626-C5043-01

28/01/2025

N/A

Valid

Effluent Discharge License under Water Pollution Control Ordinance

WT00047165-2025

15/12/2025

31/08/2030

Valid

WT00048247-2026

18/03/2026

31/03/2031

Valid (Variation of WT00048247-2026 was applied on 15 April 2026)

Construction Noise Permit (CNP)







GW-RN1510-25

01/01/2026

30/04/2026

Valid

GW-RN0230-26

24/02/2026

31/05/2026

Valid

GW-RN0251-26

28/02/2026

27/05/2026

Valid

GW-RN0201-26

01/03/2026

31/05/2026

Valid

GW-RN0205-26

01/03/2026

31/05/2026

Valid

GW-RN0381-26

24/03/2026

23/07/2026

Valid

GW-RN0426-26

01/04/2026

30/06/2026

Valid

GW-RN0402-26

03/04/2026

02/07/2026

Valid

GW-RN0401-26

03/04/2026

02/07/2026

Valid

GW-RN0461-26

07/04/2026

06/07/2026

Valid





Table 1.6 Status of Environmental License, Notifications and Permits for Works Contract No. ND/2024/06

Permit / License Name/No.

Valid Period

Status

From

To

Environmental Permit

EP-470/2013/A

13/05/2022

N/A

Valid

Notification pursuant to Air Pollution Control (Construction Dust) Regulation

10007695

06/08/2024

N/A

Valid

Billing Account for Disposal of Construction Waste

7051899

28/08/2024

N/A

Valid

Registration of Chemical Waste Producer

WPN:5213-624-W3824-01

04/09/2024

N/A

Valid

Effluent Discharge License under Water Pollution Control Ordinance

WT00046560-2025

15/05/2025

31/05/2030

Valid

WT00046847-2025

11/07/2025

31/07/2030

Valid

WT00046588-2025

29/05/2025

31/05/2030

Valid

Construction Noise Permit (CNP)







GW-RN1439-25

29/12/2025

28/04/2026

Valid until 28/04/2026



Table 1.7 Status of Environmental License, Notifications and Permits for Works Contract No. ND/2024/07

Permit / License Name/No.

Valid Period

Status

From

To

Environmental Permit

EP-476/2013

21/11/2013

N/A

Valid

Notification pursuant to Air Pollution Control (Construction Dust) Regulation

10007874

09/08/2024

N/A

Valid

Billing Account for Disposal of Construction Waste

7051974

20/08/2024

N/A

Valid

Registration of Chemical Waste Producer

WPN:5213-625-B2775-01

19/08/2024

N/A

Valid

Effluent Discharge License under Water Pollution Control Ordinance

WT00045532-2024

10/12/2024

31/12/2029

Valid

WT00046059-2025 (Part 1)

17/06/2025

28/02/2030

Valid

WT00046059-2025 (Part 2)

17/06/2025

28/02/2030

Valid

WT00046342-2025

15/05/2025

31/05/2030

Valid

WT00046692-2025

29/05/2025

31/05/2030

Valid

WT00046655-2025

03/06/2025

30/06/2030

Valid

WT00046819-2025

31/07/2025

31/07/2030

Valid

WT00047343-2025

29/09/2025

30/09/2030

Valid

WT00047250-2025

12/11/2025

30/11/2030

Valid

WT00048473-2026

17/04/2026

30/04/2031

Valid

WT00048492-2026

30/04/2026

30/04/2031

Valid

Construction Noise Permit (CNP)







GW-RN1224-25

01/11/2025

30/04/2026

Valid

GW-RN1473-25

12/12/2025

31/05/2026

Valid

GW-RN0069-26

19/01/2026

18/06/2026

Valid

GW-RN0168-26

18/02/2026

17/06/2026

Valid

GW-RN0179-26

23/02/2026

22/08/2026

Valid




2              Air Quality Monitoring

2.1          Monitoring Requirement

2.1.1       In accordance with the EM&A Manual, the approved updated EM&A Manual for the First Phase, the ET shall carry out impact monitoring during the construction phase of the Project. 1-hour and 24-hour TSP to monitor the air quality for the Works Contacts.

2.1.2       Impact 1-hour TSP monitoring was conducted for at least three times every 6 days, while the impact 24-hour TSP monitoring was conducted for at least once every 6 days at the designated air quality monitoring stations.

2.2          Monitoring Location

2.2.1       According to the EM&A Manual, the approved updated EM&A Manual for the First Phase, the designated locations for impact air quality monitoring in related to the work contracts in the reporting period are listed in Table 2.1 and their locations are shown in Figure 2.1 and Figure 2.2.

Table 2.1 Summary of Impact Air Quality Monitoring Stations in related to the Works Contracts in the Reporting Period

Monitoring Station(s)

Works Contract(s)

ASR ID in EIA

Planned(3) or Existing

Monitoring Location(s)

KTN-DMS1

ND/2024/01,

ND/2024/02,

ND/2024/03

KTN-19

Planned

Nursery Classes and Kindergarten; Post Offices

KTN-DMS2

ND/2024/01,

ND/2024/02

KTN-90

Planned

Nursery Classes and Kindergarten (2 nos); District Elderly Community Centre

KTN-DMS3

ND/2024/01,

ND/2024/02,

ND/2024/03

KTN-326

Planned

Village Resite

KTN-DMS4(B)(1)(2)

ND/2024/01,

ND/2024/03

KTN-E70

Existing

Temporary Structure at Pak Shek Au

FLN-DMS1

ND/2024/07

FLN-E62

Existing

Scattered Village Houses North of Proposed Potential Ecopark

FLN-DMS2

ND/2024/06, ND/2024/07

FLN-E243

Planned

Residential Building, Nursery Classes and Kindergartens, Neighbourhood Elderly Community Centre, Residential Home for the Elderly, Post Office

FLN-DMS5, FLN-DMS5(A)

ND/2024/07

FLN-E124

Existing

Noble Hill / Good View New Village

FLN-DMS6(A)

ND/2024/03,

ND/2024/04

DMS-10

Existing

Choi Ngan House, Choi Po Court

FLN-DMS7

ND/2024/06, ND/2024/07

FLN-20

Planned

Planned premise for Weapon Training Division

Remarks:

(1)    KTN-DMS4(B) is the alternative air monitoring stations proposed to replace KTN-DMS4.

(2)    As KTN-DMS4 - Temporary structure near Fanling Highway (near Pak Shek Au) is no longer as existing ASR, air quality monitoring station should be relocated to the alternative dust monitoring location according to the updated EM&A Manual, Section 2.6.2. According to Figure 3.1 of Approved EIA report and site visits conducted in June 2022, ASR at near KTN-E70 – Temporary Structure near Fanling Highway near Pak Shek Au is considered as the most representative alternative station KTN-DMS4(B) for air quality monitoring for KTN-DMS4 (i.e. KTN-E162).

(3)    Impact monitoring will be carried out when the planned sensitive receivers are commissioned.



2.3          Monitoring Parameter and Frequency and Duration

2.3.1       In accordance with the requirements for placement of equipment, as set out of the EM&A Manual of the Project, the approved updated EM&A Manual for the First Phase, the monitoring parameter, frequency and duration of impact air quality monitoring are listed in Table 2.2.

Table 2.2 Parameters Measured in the Impact Air Quality Monitoring

Parameter(s)

Frequency(1)(2)

1-hour TSP

Three times / 6 days

24-hour TSP

Once / 6 days

Remarks:

(1)    The air quality monitoring (1-hour and 24-hour TSP) was conducted by First Phase ET during the reporting period.

(2)    The air quality monitoring (1-hour and 24-hour TSP) was conducted by Remaining Phase ET during the reporting period.

2.4          Monitoring Equipment

2.4.1       Direct reading dust meters and High-Volume TSP Samplers were used for measuring the impact air quality monitoring (i.e. 1-hour TSP and 24-hour TSP) during the reporting period in accordance with the Service Contract No. NDO 04/2019 Monthly EM&A Report.  According to Section 2.4.5 of the EM&A Manual, the approved updated EM&A Manual for First Phase ET, the proposed use of direct reading dust meter was submitted to and agreed by the First Phase IEC. HVS for 24-hour TSP monitoring will be adopted once secured supply of electricity become available at FLN-DMS5(A) and KTN-DMS4(B).

2.4.2       Table 2.3 summarizes the equipment used in the air quality monitoring programme. Copies of the calibration certificates for air quality monitoring equipment are shown in Appendix 2.2.

Monitoring

Station(s)

Equipment

Model

Manufacturer

Quantity

KTN-DMS4(B)(1), FLN-DMS5(1), FLN-DMS5(A)(1)

Dust Monitor

(1-hour and 24-hour TSP)

AEROCET-831

Met One Instruments

8

FLN-DMS1(1)

Dust Monitor

(1-hour TSP)

HVS Sampler

(24-hour TSP)

TE-5170

Tisch

1

FLN-DMS6(A)(2)

Dust Monitor

(1-hour and 24-hour TSP)

LD-5R

Sibata

1

Table 2.3 Air Quality Monitoring Equipment

Remarks:

(1)      The air quality monitoring (1-hour and 24-hour TSP) was conducted by First Phase ET during the reporting period.

(2)      The air quality monitoring (1-hour and 24-hour TSP) was conducted by Remaining Phase ET during the reporting period.




2.5          Monitoring Methodology and QA/QC Procedure

2.5.1       Direct reading dust meter was deployed for the air quality monitoring as shown in Table 2.3.

Instrumentation

(AEROCET-831)

2.5.2       The measuring procedures of the dust meters were in accordance with the Manufacturer’s Instruction Manual as follows:

·       Place the dust meter at least 1.3 meters above ground;

·       Press and hold the Power key momentarily to power on the unit and make sure that the battery level was not flash or in low level;

·       Allow the instrument to stand for about 3 second to display the Sample Screen minutes;

·       Press the START / STOP key to run the internal vacuum pump for 1 minute and be ready to use;

·       Use the select dial to select the PM range and press the START / STOP key to start a measurement;

·       Finally, push the START/STOP key to stop the measurement after 24-hour sampling;

·       Information such as sampling date, time, value and site condition were recorded during the monitoring period; and

·        All data were recorded in the data logger for further data processing.



Maintenance/Calibration

2.5.3       The following maintenance/calibration was required for the HVS:

·       Check and calibrate the meters by High Volume Sampler (HVS) to check the validity and accuracy of the results measured by direct reading method at 2-month intervals throughout all stages of the air quality monitoring.

Instrumentation

(TISCH Model: TE-5170 / TE-5170X)

2.5.4       The following guidelines were adopted during the installation of HVS:

·       A horizontal platform with appropriate support was provided to secure the samplers against gusty wind. the dust meter at least 1.3 meters above ground;

·       No two samplers were placed less than 2 metres apart.

·       The distance between the sampler and an obstacle, such as buildings, was at least twice the height that the obstacle protrudes above the sampler.

·       A minimum of 2 metres of separation from walls, parapets and penthouses was required for rooftop samples.

·       A minimum of 2 metres separation from any supporting structure, measured horizontally was required.

·       No furnaces or incineration flues were nearby.

·       Airflow around the sampler was unrestricted.

·       The sampler were more than 20 metres from the drip line.

·       Any wire fence and gate, to protect the sampler, should not cause any obstruction during monitoring.

·       Permission and access to monitoring stations have been obtained to set up the samplers.

·       A secured supply of electricity was provided to operate the samplers.



Filters Preparation

2.5.5       Wellab Limited (HOKLAS Registration No. HOKLAS083) is a HOKLAS accredited laboratory and responsible for the preparation of 24-hour conditioned and pre-weighed filter papers for the monitoring team.

2.5.6       All filters were equilibrated in the conditioning environment for 24 hours before weighing. The conditioning environment temperature was around 25°C and not variable by more than ±3°C; the relative humidity (RH) was < 50% and not variable by more than ±5%. A convenient working RH was 40%.



Operating/Analytical Procedures

2.5.7       Operating/analytical procedures for the air quality monitoring were highlighted as follows:

·       Prior to the commencement of dust sampling, the flow rate of the HVS was properly set (between 1.1 m3 /min. and 1.4 m3 /min.) in accordance with the manufacturer's instruction to within the range recommended in USEPA Standard Title 40, CFR Part 50;

·       The power supply was checked to ensure the sampler worked properly;

·       On sampling, the sampler was operated for 5 minutes to establish thermal equilibrium before placing any filter media at the designated air quality monitoring station;

·       The filter holding frame was then removed by loosening the four nuts and carefully a weighted and conditioned filter was centered with the stamped number upwards, on a supporting screen;

·       The filter was aligned on the screen so that the gasket formed an airtight seal on the outer edges of the filter. The filter holding frame was then tightened to the filter holder with swing bolts. The applied pressure should be sufficient to avoid air leakage at the edges;

·       The shelter lid was closed and secured with the aluminium strip;

·       The timer was then programmed. Information was recorded on the record sheet, which included the starting time, the weather condition and the filter number (the initial weight of the filter paper can be found out by using the filter number);

·       After sampling, the filter was removed and kept in a clean and tightly sealed plastic bag. The filter paper was then returned to the HOKLAS accredited laboratory (Wellab Ltd.) for reconditioning in the humidity-controlled chamber followed by accurate weighting by an electronic balance with a readout down to 0.1mg. The elapsed time was also recorded; and

·       Before weighing, all filters were equilibrated in a conditioning environment for 24 hours. The conditioning environment temperature should be between 25°C and 30°C and did not vary by more than ±3°C; the RH should be < 50% and did not vary by more than ±5%. A convenient working RH is 40%. Weighing results were returned for further analysis of TSP concentrations collected by each filter



Maintenance/Calibration

2.5.8       The following maintenance/calibration was required for the HVS:

·       The high-volume motors and their accessories were properly maintained. Appropriate maintenance such as routine motor brushes replacement and electrical wiring checking were made to ensure that the equipment and necessary power supply are in good working conditions; and

·       All HVS were calibrated (five point calibration) using Calibration Kit prior to the commencement of baseline monitoring and thereafter at bi-monthly intervals.

Instrumentation

(Sibata Model: LD-5R)

2.5.9       The measuring procedures of the dust meters were in accordance with the Manufacturer’s Instruction Manual as follows:

·       Placed the dust meters at least 1.3m above ground

·       Set POWER to “ON” and make sure that the battery level not flashed or in low level;

·       Pulled the air sampling inlet cover up;

·       Pushed the knob at MEASURE position;

·       Set time/mode setting to [BG] by pushing the time setting switch. Then, started the background measurement by pushing the start/stop switch once. It took 6 sec. to complete the background measurement;

·       Turned knob to SENSI. ADJ position and pressed in;

·       Pushed Start/Stop switch once;

·       Gently returned knob to the MEASURE position;

·       Pushed the time setting switch to change the time setting display to [LOG] at the bottom left of the liquid crystal display;

·       Removed the cap and started measurement; and

·       Information such as sampling date, time, count value and site condition were recorded during the monitoring period.





Maintenance/Calibration

2.5.10    The following maintenance/calibration was required for the direct reading dust meter:

·       Direct reading dust meter shall be used in determining 1-hour TSP and 24-hour TSP at air quality monitoring points. The direct reading dust meters have been calibrated against high volume samplers (HVSs) bi-monthly. A 2-day, three 3-hour measurement results per day from direct reading dust meters were taken to compare with the sampling results from the HVSs. The correlation between the direct reading dust meters and the HVSs were then concluded. By accounting for the correlation factor, the direct reading dust meters are considered to achieve comparable results as that of the HVSs.

·       The HVS used to calibrate the direct dust monitor will need to be calibrated bi-monthly. Details of maintenance and calibration for the HVS refers to Section 2.5.8. Calibration for the air quality monitoring equipment is attached to the Appendix 2.2.

2.6          Action and Limit Level for Air Quality Monitoring

2.6.1          The baseline monitoring results formed the basis for determining the air quality criteria for the impact monitoring. The ET shall compare the impact monitoring results with air quality criteria set up for 1-hour TSP and 24-hour TSP. Based on the baseline dust monitoring data and the derivation criteria specified above, the Action/Limit Levels for 1-hour TSP and 24-hour TSP are presented in Table 2.4 and Table 2.5 respectively.

Table 2.4 Action and Limit Levels for 1-hour TSP Air Quality Monitoring

Monitoring Station

AL (μg/m3)

LL (μg/m3)

KTN-DMS4(B)

297

500

FLN-DMS1

303

500

FLN-DMS5

279

500

FLN-DMS6(A)

286

500



Table 2.5 Action and Limit Levels for 24-hour of TSP Air Quality Monitoring

Monitoring Station

AL (μg/m3)

LL (μg/m3)

KTN-DMS4(B)

192

260

FLN-DMS1

150

260

FLN-DMS5(A)

153

260

FLN-DMS6(A)

157

260



2.7          Results and Observations

2.7.1       Air quality monitoring was conducted as scheduled in the reporting period. The air quality monitoring schedule during the reporting period is shown in the Appendix 2.1.

2.7.2       The 1-hour and 24-hour TSP air quality monitoring result in the reporting period are summarized in Table 2.6 and 2.7.  No Action or Limit levels exceedance was recorded in the reporting period.  Details of the results and graphical presentation are shown in Appendix 2.2.

      The weather information during the reporting period is presented in Appendix 2.3.

Table 2.6 Summary Table of 1-hour TSP Monitoring Result during the Reporting Month

Monitoring

Station

Averaged Measured Value (μg/m3)

Maximum Measured

Value (μg/m3)

Minimum Measured Value (μg/m3)

Action Level (μg/m3)

Limit Level, (μg/m3)

KTN-DMS4(B)(1)

43

67

26

297

500

FLN-DMS1(1)

56

106

25

303

500

FLN-DMS5(1)

39

55

22

279

500

FLN-DMS6(A)(2)

60

75

47

286

500

Remarks:

(1)      The air quality monitoring (1-hour and 24-hour TSP) was conducted by First Phase ET during the reporting period.

(2)      The air quality monitoring (1-hour and 24-hour TSP) was conducted by Remaining Phase ET during the reporting period.



Table 2.7 Summary Table of 24-hour TSP Monitoring Result during the Reporting Month

Monitoring

Station

Averaged Measured Value (μg/m3)

Maximum Measured

Value (μg/m3)

Minimum Measured

 Value (μg/m3)

Action Level (μg/m3)

Limit Level, (μg/m3)

KTN-DMS4(B)(1)

50

59

43

192

260

FLN-DMS1(1)

26

31

24

150

260

FLN-DMS5(A) (1)

60

76

42

153

260

FLN-DMS6(A)(2)

70

81

56

157

260

Remarks:

(1)      The air quality monitoring (1-hour and 24-hour TSP) was conducted by First Phase ET during the reporting period.

(2)      The air quality monitoring (1-hour and 24-hour TSP) was conducted by Remaining Phase ET during the reporting period.

2.7.3       According to the observation record from Monthly EM&A Report (April 2026) prepared under Service Contract No. NDO 04/2019, the major dust source KTN-DMS4(B), FLN-DMS1, FLN-DMS5 and FLN-DMS5(A) included excavator, concrete mixer truck, crane, road traffic, dump truck and road traffic etc. For station conducted by Remaining Phase ET, the major dust source for FLN-DMS6(A) is from road traffic.




2.8          Event and Action Plan

2.8.1       Should any non-compliance of the criteria occur, action in accordance with the Event and Action Plan in Appendix 2.4 shall be followed. Investigation of the exceedances of environmental quality performance limits should be conducted, and the ET will immediately notify the IEC and EPD, as appropriate.  The notification should be followed up with advice to the IEC and EPD on the results of the investigation, proposed actions and success of the action taken, with any necessary follow-up proposals.


3              Construction Noise Monitoring

3.1          Monitoring Requirements

3.1.1       In accordance with the approved Updated EM&A Manual, the ET shall carry out impact monitoring during the construction phase of the Project in terms of the A-weighted equivalent continuous sound pressure level (Leq) to monitor the construction noise arising from the construction activities. The regular monitoring frequency for each monitoring station was on a weekly basis and one set of measurements between 0700 and 1900 hours on normal weekdays shall be conducted.

3.2          Monitoring Locations

3.2.1       According to the approved Updated EM&A Manual, the monitoring designated locations for construction noise monitoring in related to the works contracts in the reporting period are listed in Table 3.1 and shown in Figure 3.1 and Figure 3.2.

Table 3.1 Construction Noise Monitoring Stations near in related to the Works Contracts in the Reporting period

Monitoring Station(s)

Works Contract(s)

NSR

EIA ID(s)

Location(s)

Planned(2)

Or

Existing

Type of Measurement

CP-KTN-NMS1

ND/2024/01,

ND/2024/02

CP-NMS1

Residential Building at Ma Tso Lung

Existing

Free-Field(1)

CP-KTN-NMS2

ND/2024/01,

ND/2024/02

CP-NMS2

Residential Building at Ma Tso Lung

Existing

Free-Field(1)

CP-KTN-NMS3

ND/2024/01,



CP-NMS3

Fung Kong Garden

Existing

CP-KTN-NMS4(3)

ND/2024/01,

ND/2024/02,

ND/2024/03

CP-NMS5

Primary School

Planned

CP-KTN-NMS5

ND/2024/06

CP-NMS7

N/A

Existing

Free-Field(1)

CP-KTN-NMS6

ND/2024/01,

ND/2024/02

N/A

Ho Sheung Heung, Hau Ku ShekAncestral Hall, Hung Shing Temple & Pai Fung Temple and Sin Wai Nunnery

Existing

Façade

CP-KTN-NMS7

ND/2024/01, ND/2024/02

CP-NMS4

Oi Lok Home

Existing

Free-Field(1)

CP-FLN-NMS4(A)(4)

ND/2024/04

CP-NMS6

Choi Ying House,

Choi Po Court

(Choi Yuen Estate)

Existing

Free-Field(1)

CP-FLN-NMS1

ND/2024/06, ND/2024/07

CP-NMS10

Belair Monte

Existing

Facade

CP-FLN-NMS3(3)

ND/2024/06,

ND/2024/07

CP-NMS12

Secondary School

Planned

Free-Field(1)

CP-FLN-NMS5

ND/2024/07

CP-NMS8

Man Kok Village

Existing

Free-Field(1)

CP-FLN-NMS6

ND/2024/07

CP-NMS9

Woodland Crest

Existing

Façade

Remarks:

(1)      For Free Field measurement, +3 dB(A) should be added to the measured results.

(2)      Impact monitoring will be carried out when the planned sensitive receivers are commissioned.

(3)      As confirmed with Engineer Representative, the planned school at CP-KTN-NMS4 and CP-FLN-NMS3 are not constructed yet.  Thus, the impact noise monitoring will be carried out at monitoring station CP-KTN-NMS4 and CP-FLN-NMS3 after the construction and occupation of the planned school.  No noise monitoring of the mentioned station was carried out in this reporting period.

(4)      Alternative monitoring stations to the corresponding original monitoring stations.





3.3          Noise Monitoring Parameter, Frequency and Duration

3.3.1       Construction noise level was measured by the ET and measured in terms of the A-weighted equivalent continuous sound pressure level (Leq).  Leq(30mins) used as the monitoring parameter for the construction noise monitoring.

3.3.2       As supplementary information for data auditing, statistical results such as L10 and L90 were also obtained for reference.

3.3.3       Table 3.2 summarizes the monitoring parameters, duration, and frequency of construction noise monitoring.



Table 3.2 Construction Noise Monitoring Parameter, Frequency and Duration

Monitoring Station

Parameter

Frequency and Duration

CP-KTN-NMS1(2), CP-KTN-NMS2(1), CP-KTN-NMS3(1), CP-KTN-NMS5(1), CP-KTN-NMS6(1),CP-KTN-NMS7(2),CP-FLN-NMS1(1), CP-FLN-NMS4(A)(2), CP-FLN-NMS5(2), CP-FLN-NMS6(2)

Leq(30mins), L10 and

L90  (as six consecutive Leq,5min readings)

Once every week throughout the construction phase

Remark:

(1)      The noise monitoring was conducted by First Phase ET during the reporting period.

(2)      The noise monitoring was conducted by Remaining Phase Environmental Team during the reporting period.





3.4          Monitoring Equipment, Methodology and QA / QC Procedure

3.4.1       As referred to the technical memorandum issued under the Noise Control Ordinance (NCO), sound level meters in compliance with the International Electrotechnical Commission Publications 651: 1979 (Type 1) and 804: 1985 (Type 1) specifications were used for carrying out the construction noise monitoring.

3.4.2       Noise measurements were not made in fog, rain, wind with a steady speed exceeding 5 m/s or wind with gusts exceeding 10 m/s. The wind speed was checked with a portable wind speed meter capable of measuring the wind speed in m/s.

3.4.3       Sufficient numbers of noise measuring equipment and associated instrumentation were prepared by the ET. All the equipment and associated instrumentation were clearly labelled.

3.4.4       The monitoring procedures are as follows:

·       For façade measurement, the monitoring station was set at a point 1 m from the exterior of the sensitive receivers building façade and set at a position 1.2 m above the ground. For free-field measurement, the monitoring station was set at a position 1.2 m above the ground.

·       The battery condition was checked to ensure good functioning of the meter.

·       Parameters such as frequency weighting, the time weighting and the interval were set as follows:

-       Frequency weighting: A

-       Time weighting: Fast

-       Interval: 30 minutes (Leq(30mins))

·       Prior to and after each noise measurement, the meter was calibrated using an acoustic calibrator for 94.0 dB at 1000 Hz.  If the difference in the calibration level before and after measurement is more than 1.0 dB, the measurement was considered invalid and repeat of noise measurement will be required after re-calibration or repair the equipment.

·       At the end of the monitoring period, the values of Leq, L10 and L90 were recorded.  In addition, noise sources were recorded on a standard record sheet.

3.4.5       Table 3.3 summarizes the noise monitoring equipment used during the reporting period. Copies of the calibration certificates for noise monitoring are shown in Appendix 3.1

Table 3.3 Construction Noise Monitoring Equipment

Equipment

Manufacturer

Model

No. of Equipment

Serial No.

Sound Level Meter

NTi Audio(2)

XL2

2

A2A-17638-E0

A2A-13661-E0

XL3

1

A3A-01220-F0

BSWA(1)

BSWA 308

3

580006

580011

580013

Acoustic Calibrator

RION(2)

NC-75

2

35124527

35124529

SVANTEK(1)

SV30A

3

24803

24791

24780

Remark:

(1)    The noise monitoring equipment was used by First Phase ET during the reporting period.

(2)    The noise monitoring equipment was used by Remaining Phase Environmental Team during the reporting period.

3.5          Maintenance and Calibration

3.5.1       Maintenance and calibration procedures are as follows:

·       The microphone head of the sound level meter and calibrator were regularly cleaned with a soft cloth;

·       The sound level meter and acoustic calibrator were calibrated annually; and

·       The accuracy of the sound level meter was checked using an acoustic calibrator generating a known sound pressure level at a known frequency immediately prior to and following each noise measurement. Measurements were accepted as valid only if the calibration level from before and after the noise measurement agree to within 1.0 dB.

3.6          Action and Limit Levels

3.6.1       The Action and Limit levels were established in accordance with the Updated EM&A Manual. Table 3.4 presents the Action and Limit Levels for construction noise. Should non-compliance of the criteria occur, action in accordance with the Event and Action Plan presented in Appendix 3.2 shall be carried out.

Table 3.4 Action and Limit Levels for Construction Noise Monitoring

Time Period

Action

Limit Level

07:00 – 19:00 on normal weekdays

When one or more documented complaints are received

75 dB(A)

Remark:

(1)    Time period for construction noise monitoring during normal construction working hour (0700-1900 Monday to Saturday).

(2)    If works are to be carried out during restricted hours, the conditions stipulated in the Construction Noise Permit (CNP) issued by the Noise Control Authority have to be followed.

(3)    70 dB(A) and 65 dB(A) for schools during normal teaching periods and school examination periods, respectively.





3.7          Results and Observations

3.7.1       All noise monitoring was conducted as scheduled in the reporting month. The noise monitoring schedule during the reporting period is shown in the Appendix 2.1.

3.7.2       Three Action Level exceedances for construction noise were recorded during the reporting month, corresponding to three noise-related complaints received. No Limit Level exceedance was recorded for construction noise monitoring in the reporting period.  Details of the results and graphical presentation are shown in Appendix 3.1. The construction noise monitoring results are summarized in Table 3.5. The major noise sources observed during impact noise monitoring are summarized in Table 3.6.

Table 3.5 Summary of Construction Noise Monitoring Results during the Reporting Month

Works Contracts

Monitoring Stations

Noise Levels, Leq(30min), dB(A)

Baseline Levels, dB(A)

Limit Levels, dB(A)

ND/2024/01, ND/2024/02

CP-KTN-NMS1(1)(3)

51.7 – 59.5

65.7

75

CP-KTN-NMS2(1)(2)

52.5 – 65.2

58.6

CP-KTN-NMS3(1)(2)

52.1 – 60.5

51.6

CP-KTN-NMS6(2)

54.4 – 68.1

55.1

CP-KTN-NMS7(1)(3)

63.2 – 66.5

64.6

ND/2024/04

CP-FLN-NMS4(A)(1)(3)(4)

70.6 – 73.9

72.4

ND/2024/06

CP-KTN-NMS5(1)(2)

50.9 – 64.7

57.2

ND/2024/06, ND/2024/07

CP-FLN-NMS1(2)

65.1 – 68.6

69.9

ND/2024/07

CP-FLN-NMS5(1)(3)

65.7 – 67.7

69.5

CP-FLN-NMS6(3)

51.9 – 60.1

55.0

Remarks:

(1)      For Free Field measurement, +3 dB(A) was added to the measured results.

(2)      The noise monitoring was conducted by First Phase ET during the reporting period.

(3)      The noise monitoring was conducted by Remaining Phase Environmental Team during the reporting period.

(4)      Alternative monitoring stations to the corresponding original monitoring stations.





Table 3.6 Summary of Observations at Noise Monitoring Stations

Works Contracts

Monitoring Stations

Location

Major Noise Sources

ND/2024/01, ND/2024/02

CP-KTN-NMS1

Residential Building at Ma Tso Lung

Household noise (dog barking) from nearby village house

CP-KTN-NMS2

Residential Building at Ma Tso Lung

Road Traffic Noise

CP-KTN-NMS3

Fung Kong Garden

Road Traffic Noise, Excavator, Dump Truck, Crane

CP-KTN-NMS4

Primary School

N/A(1)

CP-KTN-NMS6

Ho Sheung Heung, Hau Ku Shek Ancestral Hall, Hung Shing Temple & Pai Fung Temple and Sin Wai Nunnery

Road Traffic Noise

CP-KTN-NMS7

Oi Lok Home

Road Traffic Noise

ND/2024/04

CP-FLN-NMS4(A)(2)

Choi Ying House,

Choi Po Court

(Choi Yuen Estate)

Road Traffic Noise

ND/2024/06

CP-KTN-NMS5

N/A

Road Traffic Noise

ND/2024/06, ND/2024/07

CP-FLN-NMS1

Belair Monte

Road Traffic Noise, Excavator, Dump Truck, Crane Truck, Hand Breaker

CP-FLN-NMS3

Secondary School

N/A(1)

ND/2024/07

CP-FLN-NMS5

Man Kok Village

Road Traffic Noise

CP-FLN-NMS6

Woodland Crest

No construction activity and other noise source was observed

Remarks:

(1)       No impact noise monitoring was carried out at the monitoring station. Thus, not applicable (N/A).

(2)       Alternative monitoring stations to the corresponding original monitoring stations.

3.7.3       Three noise related complaints were received during the reporting period. The details of the complaints and investigation results are shown in Appendix 12.1.

3.8          Event and Action Plan

3.8.1       Should non-compliance of the noise monitoring criteria occur, actions in accordance with the Event and Action Plan in Appendix 3.4 shall be carried out.




4              Water Quality

4.1          Monitoring Requirement

4.1.1       In accordance with the approved Updated EM&A Manual and EM&A Manual, impact water quality monitoring shall be carried out three days per week at all the designated monitoring stations during the construction of channel. The measurement periods are specified in Table 4.1. The interval between two sets of monitoring shall not be less than 36 hours.

Table 4.1 Summary of Water Quality Monitoring Locations

New Monitoring Station(s)

Original Monitoring Station ID(s)

Description

Location(s)

Measurement

Period

KTN NDA

KTN-CS1

CS1

Control Station for KTN NDA

Centreline of river, upstream of the channel

During construction of channel

KTN-IS1

IS1

Impact Station for KTN NDA

Centreline of river, downstream of the channel

During construction of channel

FLN NDA

FLN-CS1

CS2

Control Station for FLN NDA

Centreline of river, upstream of the channel

During construction of channel

FLN-IS1

IS2

Impact Station for FLN NDA

Centreline of river, downstream of the channel

During construction of channel

4.2          Result and Observations

4.2.1       No construction of channelisation work between KTN-CS1, KTN-IS1, FLN-CS1 and FLN-IS1 were undertaken during the reporting period. Therefore, no water quality monitoring was carried out.






5              Waste Management

5.1.1       Waste generated from the Project include inert construction and demolition (C&D) materials and non-inert C&D wastes in the reporting period. The cumulative waste flow table of the Project was presented in in Appendix 5.1.

5.1.2       Sorting of construction and demolition (C&D) materials was carried out on site. Sufficient numbers of receptacles were provided for general refuse collection and sorting.  Excavated inert C&D materials were reused to minimize the disposal of C&D waste to public fill.

5.1.3       The Contractor is advised to minimize the wastes generated through recycling or reusing.  All applicable mitigation measures stipulated in the Updated EM&A Manual and waste management plans will be fully implemented.


6              Ecology

6.1          Introduction

6.1.1       This section was derived from the ecological monitoring conducted during the construction phase by the Remaining Phase ET, supplemented with findings retrieved from the First Phase ET under Service Contract No. NDO 04/2019 Environmental Team for Environmental Monitoring and Audit Works in Construction Phase for the First Phase Development of Kwu Tung North and Fanling North New Development Areas. This approach was undertaken to prevent redundancy in survey efforts.

6.2          Monitoring Requirements

Weekly Site Inspection

6.2.1       Weekly site inspections by the ET from the First Phase of the KTN/FLN NDAs Project for ecological mitigation measures are conducted as part of the overall weekly environmental site inspections. These inspections audit the ecological mitigation measures implemented within the active works area to ensure that the activities do not significantly impact the ecologically sensitive receivers in the active works areas.

Monitoring of Measures to Minimise Disturbance to Water Birds in Ng Tung River, Sheung Yue River, Shek Sheung River and Long Valley

6.2.2       As stipulated in Section 12.3.2.5 of the Updated EM&A Manual, if development under the NDAs project occurs within 200m of Sheung Yue River, Ng Tung River, Shek Sheung River and Long Valley, weekly transect monitoring at high and low tides (above/below 1.5m at Tsim Bei Tsui Station) should be conducted. The monitoring aims to identify and count bird species in the river channels and Long Valley Nature Park (LVNP) and detect any disturbances from construction activities, following the methodology in Table 12.1 of the Updated EM&A Manual. Monitoring in Long Valley should follow the Hong Kong Bird Watching Society (HKBWS) bird monitoring programme's methodology for comparable and comprehensive results.

Monitoring of Measures to Minimise Impacts to Ma Tso Lung Stream and Siu Hang San Tsuen Stream, and Long Valley

6.2.3       As stipulated in Section 12.3.2.14 of the Updated EM&A Manual, aquatic fauna monitoring should be conducted monthly during the wet season (April – October) of the construction phase.




Monitoring of Measures to Minimise Impacts on Ecological Sensitive Habitats from Disturbance and Pollution

6.2.4       As stipulated in Section 12.3.2.17 of the Updated EM&A Manual, measures to minimize impacts should be monitored during the construction phase. The purpose of these surveys is to assess the effectiveness of measures aimed at reducing disturbances and pollution in ecologically sensitive habitats through standard fauna transect surveys.

6.2.5       For this reporting month, only transects that are relevant to the active works of Works Contract ND/2024/01, Contract No. ND/2024/02, Contract No. ND/2024/03, Contract No. ND/2024/04, Contract No. ND/2024/06, Contract No. ND/2024/07 and Contract No. ND/2024/08, were included. The active works for the mentioned contracts are described in Section 1.3.1 of this report and shown in Figure 1.1 and Figure 1.2.

6.2.6       Table 6.1 summarizes the relevant transects and monitoring station to each contract under the remaining phase, categorised under the column “First Phase ET” and “Remaining Phase ET” according to the current survey efforts. The locations of these contracts relative to the monitoring locations are shown in Figure 6.1 and Figure 6.2.

Table 6.1 Summary of Monitoring Activities, Relevant Contracts, and Corresponding Transects

Monitoring Activity

Relevant Works Contract(s)

Relevant Transect(s)/Monitoring Station(s)

First Phase ET

Remaining Phase ET

Monitoring of Measures to Minimise Disturbance to Water Birds on Ng Tung, Sheung Yue, and Shek Sheung Rivers and Long Valley

ND/2024/01*

T1, T2, T3, T5

-

ND/2024/02*

T1, T2, T3, T5

T4

ND/2024/03*

T1, T2, T3, T5

-

ND/2024/04*

-

T4

ND/2024/05

N/A(1)

N/A(1)

ND/2024/06*

T1, T2, T3

-

ND/2024/07*

T1, T2, T3

T4

ND/2024/08*

T1, T2, T3

T4

Monitoring of Measures to Minimise Impacts to Ma Tso Lung Stream and Siu Hang San Tsuen Stream, and Long Valley

ND/2024/01*^

MS_01, MS_02, MS_03, MS_04, MS_05, MS_06,  MS_07, MS_08, MS_09, MS_10

-

ND/2024/02*^

MS_01, MS_02, MS_03, MS_04, MS_05, MS_06,  MS_07, MS_08, MS_09, MS_10

-

ND/2024/03*

N/A(2)

N/A(2)

ND/2024/04*

N/A(2)

N/A(2)

ND/2024/05

N/A(2)

N/A(2)

ND/2024/06*

N/A(2)

N/A(2)

ND/2024/07*^

MS_11, MS_12, MS_13, MS_14, MS_15

-

ND/2024/08*^

MS_11, MS_12, MS_13, MS_14, MS_15

N/A(2)









Monitoring of Measures to Minimise Impacts on Ecological Sensitive Habitats from Disturbance and Pollution

ND/2024/01*

T1

-

ND/2024/02*

T1, T6

-

ND/2024/03*

T4

-

ND/2024/04*

N/A(3)

N/A(3)

ND/2024/05

T4, T6

-

ND/2024/06*

-

T2

ND/2024/07*

T3

-

ND/2024/08*

T3

-



Remarks:

(1)      Contracts that are located relatively far from river channels.

(2)      Contracts that are located relatively far from Ma Tso Lung and Siu Hang San Tsuen streams.

(3)      Contracts that are located relatively far from the Ecological Sensitive Habitats as identified in the EIA.

(4)      * = active works contracts (ND/2024/01, ND/2024/02, ND/2024/03, ND/2024/04, ND/2024/06, ND/2024/07 and ND/2024/08); ^ = monitoring only in April – October’.

6.2.7       The details of the relevant monitoring activities are discussed in the succeeding sections.

6.3          Results and Observations

Monitoring of Measures to Minimise Disturbance to Water Birds in Ng Tung River, Sheung Yue River, Shek Sheung River and Long Valley

Monitoring Methodology

6.3.1       Birds identified by their calls but not visually located were recorded as "heard", while those observed flying over the survey area were noted as "in flight." Species of conservation importance were also specified. Additional information at the time of the survey, such as weather conditions, tidal conditions, tide levels, and noticeable natural or anthropogenic activities, were documented. For the avifauna survey, ornithological nomenclature referenced The Avifauna of Hong Kong (Carey et al., 2001), The Birds of Hong Kong and South China (Viney et al., 2005), and the most recent updated lists from other sources (e.g., Hong Kong Bird Watching Society).



Monitoring Parameters

6.3.2       The monitoring parameters are as follows:

·       Abundance of birds;

·       Types of habitats utilized by birds; and

·       Notable bird behaviours such as roosting, feeding, nesting and presence of juveniles.



Monitoring Location

6.3.3       For this reporting month, First Phase ET conducted avifauna monitoring at Ng Tung River, Sheung Yue River, and Long Valley, while the Remaining Phase ET conducted avifauna monitoring at Shek Sheung River. Relevant transect routes are summarized in Table 6.2 and illustrated in Figure 6.1 and Figure 6.2. As the sensitive receivers are large waterbirds and are easily visible, the transect routes only needed to follow one riverbank.

Table 6.2 Summary of Active Works Contracts and Corresponding Transects

Monitoring
Transect(s)

Relevant Works Contract(s)

ND/2024/01

ND/2024/02

ND/2024/03

ND/2024/04

ND/2024/06

ND/2024/07

ND/2024/08

T1. Ng Tung River



T2. Ng Tung River



T3. Sheung Yue River



T4. Shek Sheung River







T5. Long Valley









Monitoring Frequency

6.3.4       Avifauna monitoring at high and low tides should be conducted weekly. Additionally, nighttime monitoring in Long Valley should be conducted twice a month from September to April, which is not required for the reporting month.

6.3.5       For this reporting month, waterbird monitoring was conducted by both the First Phase ET (T1, T2, T3 and T5) and Remaining Phase ET (T4). Survey date for each monitoring is shown in Table 6.3.

Table 6.3 Monitoring Programme for Waterbirds Monitoring, April 2026

Week

Date

Transect(1)

1

1 April 2026

T4

2

8 April 2026

T4

9 April 2026

T3, T5

10 April 2026

T1, T2, T4

3

14 April 2026

T3, T4, T5

16 April 2026

T4

17 April 2026

T1, T2

4

20 April 2026

T3, T5

21 April 2026

T4

22 April 2026

T4

23 April 2026

T1, T2

5

28 April 2026

T1, T2, T4

30 April 2026

T3, T4, T5

Additional Nighttime
Monitoring in Long Valley

20 April 2026

T5

30 April 2026

Remarks:

(1)    Transects T1, T2, T3, and T5 are relevant to Works Contract ND/2024/01 and ND/2024/03; Transect T4 is relevant to Works Contract ND/2024/04; Transects T1, T2, and T3 are relevant to Works Contract ND/2024/06; Transects T1, T2, T3 and T4 are relevant to Works Contract ND/2024/07 and ND/2024/08; Transect T1, T2, T3, T4 and T5 are relevant to Works Contract No. ND/2024/02.

Monitoring Results

6.3.6       For this reporting month, only monitoring results in Transects T1, T2, T3, T4 and T5 are reported as not all of these monitoring data are relevant to active Works Contract ND/2024/01, ND/2024/02, ND/2024/03, ND/2024/04, ND/2024/06, ND/2024/07 and ND/2024/08 as summarised in Table 6.1.

6.3.7       Transect T1 and T2 were conducted along the Ng Tung River. For Transect T1, a total of 3 species of large waterbirds, namely Grey Heron (4 individuals), Great Egret (7 individuals) and Little Egret (39 individuals), were recorded in the reporting month. For Transect T2, a total of 3 species of large waterbirds, namely Grey Heron (11 individuals), Great Egret (12 individuals) and Little Egret (56 individuals), were recorded in the reporting month.

6.3.8       Transect T3 was conducted along the Sheung Yue River. A total of 3 species of large waterbirds, namely Grey Heron (2 individuals), Great Egret (7 individuals) and Little Egret (122 individuals), were recorded for the reporting month.

6.3.9       Transect T4 was conducted along the Shek Sheung River. A total of 2 species of large waterbirds, namely Great Egret (4 individuals) and Little Egret (19 individuals), were recorded during the reporting month.

6.3.10    Transect T5 was conducted in Long Valley Nature Park with the highest species diversity and abundance recorded. A total of 4 species of large waterbirds, namely Grey Heron (1 individual), Great Egret (3 individuals), Intermediate Egret (6 individuals) and Little Egret (32 individuals), were also found to utilise the habitat.

6.3.11    Chinese Pond Heron, the most abundant waterbird species recorded during the baseline survey, which is strictly associated with wetlands, was widely noted across different transect routes in the reporting month 148 individuals recorded in total. 21 individuals were noted along Transect T1, 29 individuals along Transect T2, 20 individuals along Transect T3, 18 individuals along Transect T4, and 60 individuals were noted along Transect T5.

6.3.12    Relevant results of the avifauna monitoring conducted by the First Phase ET during this reporting month are detailed in Appendix 6.1a to Appendix 6.1j. Findings of surveys conducted by the Remaining Phase ET during this reporting month are detailed in Appendix 6.1k to Appendix 6.1o.

6.3.13    Table 6.4 summarizes the results of the monitoring of measures to minimize disturbance to waterbirds in Ng Tung River, Sheung Yue River, Shek Sheung River and Long Valley of the reporting month.




Table 6.4 Summary Table of Waterbird Monitoring Results Relative to Corresponding Action and Limit Levels, April, Transects T1, T2, T3, T4 and T5

Monitoring Parameter

Result in Reporting Month
(April 2026)

Baseline Level in Corresponding Month
(April 2020)

Action
Level (1)

Limit
Level (2)

T1, T2 and T3

Mean abundance of large waterbirds using Ng Tung River, Sheung Yue River and Shek Sheung River (3)

65

19

13

9

Mean abundance of Chinese Pond Heron using Ng Tung River, Sheung Yue River and  Shek Sheung River

18

15

10

7

T4

Mean abundance of large waterbirds using Shek Sheung River (3)

5

4

3

2

Mean abundance of Chinese Pond Heron using Shek Sheung River

4

5

3

2

T5 Long Valley

Mean Abundance of birds (all species) recorded in LVNP

574

496

347

248

Mean abundance of the Chinese Pond Heron

15

12

8

6

Environmental disturbance and damage from activities in LVNP

-

-

Activity likely to cause unacceptable

environmental

disturbance or

damage noted in LVNP.

Activity likely to cause unacceptable

environmental

disturbance or

damage noted in LVNP.

Remarks:

(1)      Exceedance of Action Level occurs when the monitoring result is lower than the Action Level.

(2)      Exceedance of Limit Level occurs when the monitoring result is lower than the Limit Level.

(3)      Large waterbird species for mean abundance calculation include Great Cormorant (Phalacrocorax carbo); Grey Heron (Ardea cinerea); Great Egret (Ardea alba); Intermediate Egret (Ardea intermedia); Little Egret (Egretta garzetta) and Chinese Egret (Egretta eulophotes).



6.3.14    No exceedance in Action or Limit Level was recorded for the reporting month.




Monitoring of Measures to Minimise Impacts to Ma Tso Lung Stream and Siu Hang San Tsuen Stream, and Long Valley

6.3.15    Monitoring of larger organisms such as fish species will be carried out through direct counting, while sampling aquatic invertebrates will involve kick-netting and sweep-netting. Three replicates will be conducted for invertebrate sampling at each sampling point. During kick-netting, the net will be positioned at a location with the opening facing the water current while disturbing the substrate through kicking to dislodge organisms from the stream bed. Sweep-netting will be applied to water bodies without water current according to on-site conditions. Species observed will be identified to the lowest possible taxonomic level with their relative abundance recorded, with the use of dissecting microscope especially for small organisms not identifiable through the naked eye.

Monitoring Parameters

6.3.16    The monitoring parameters are as follows:

·       Species composition and abundance;

·       Distribution of invertebrates and fish fauna; and

·       Specify species of conservation importance, if any.

Monitoring Locations

6.3.17    For this reporting month, the First Phase ET conducted the aquatic fauna monitoring along Ma Tso Lung Stream and Siu Hang Sang Tsuen Stream. Specifically, the monitoring stations relevant for the active works under Works Contract ND/2024/01 and ND/2024/02 are:

·       MS_01

·       MS_02

·       MS_03

·       MS_04

·       MS_05

·       MS_06

·       MS_07

·       MS_08

·       MS_09

·       MS_10

And the relevant monitoring stations for Works Contract ND/2024/07 and ND/2024/08 are:

·       MS_11

·       MS_12

·       MS_13

·       MS_14

·       MS_15

6.3.18    The above monitoring stations are shown in Figure 6.1 and Figure 6.2.

Monitoring Frequency

6.3.19    As stated in Section 12.3.2.14 of the Updated EM&A Manual, aquatic fauna monitoring should be conducted monthly during the wet season (April – October) during the construction phase.

6.3.20    For this reporting month, aquatic fauna monitoring was conducted by the First Phase ET on 22 April 2026.




Monitoring Results

6.3.21    A total of 24 species of aquatic invertebrates and 5 species of fish were recorded along the Ma Tso Lung Stream and Siu Hang San Tsuen Stream for the reporting month. One native aquatic invertebrate species of conservation importance (larva of Club-tailed Cruiser) was noted for the reporting month, according to the findings of the First Phase ET. A complete species list is enclosed as Appendix 6.2.

6.3.22    4 monitoring stations, namely MS_01, MS_03, MS_05 and MS_12, were found to be dried-up. Thus, no aquatic fauna species were recorded.

6.3.23    Table 6.5 and Table 6.6 summarized the aquatic monitoring results for the reporting month.

Table 6.5 Summary Table of Monitoring Results for Aquatic Invertebrates Relative to Action and Limit Levels, April, Monitoring Station MS_01 – MS_15

Monitoring Station

Result in Reporting Month (April 2026) (1)

Baseline Level in Corresponding Month (April 2020) (1)

Action Level(2)

Limit Level(3)

MS_01

0

0

N/A

N/A

MS_02 and MS_03

2

3

2

1

MS_04, MS_06 and MS_07

6

5

4

3

MS_05

0

0

N/A

N/A

MS_08, MS_09 and MS_10

7

5

4

3

MS_11

0

0

N/A

N/A

MS_12

0

0

N/A

N/A

MS_13 and MS_14

4

3

2.1

1

MS_15

0

0

N/A

N/A

Remarks:

(1)      Number of native species (species richness) recorded.

(2)      Exceedance of Action Level occurs when the monitoring result is lower than the Action Level.

(3)      Exceedance of Limit Level occurs when the monitoring result is lower than the Limit Level.

Table 6.6 Summary Table of Monitoring Results for Fish Species Relative to Action and Limit Levels, April, Monitoring Station MS_01 – MS_15

Monitoring Station

Result in Reporting Month (April 2026) (1)

Baseline Level in Corresponding Month (April 2020) (1)

Action Level(2)

Limit Level(3)

MS_01

0

0

N/A

N/A

MS_02 and MS_03

0

1

N/A

N/A

MS_04, MS_06 and MS_07

1

2

N/A

1

MS_05

0

0

N/A

N/A

MS_08, MS_09 and MS_10

1

2

N/A

1

MS_11

0

0

N/A

N/A

MS_12

0

0

N/A

N/A

MS_13 and MS_14

1

1

N/A

N/A

MS_15

0

0

N/A

N/A

Remarks:

(1)    Number of native species (species richness) recorded.

(2)      Exceedance of Action Level occurs when the monitoring result is lower than the Action Level.

(3)      Exceedance of Limit Level occurs when the monitoring result is lower than the Limit Level.

6.3.24    No exceedance in Action or Limit Level was recorded for the reporting month.

Monitoring of Measures to Minimise Impacts on Ecological Sensitive Habitats from Disturbance and Pollution

Monitoring Methodology

Terrestrial Mammal

6.3.25    Mammal surveys were conducted both during the day and at night along transect routes that may be potentially utilized by terrestrial mammals. Observations included field signs such as droppings, footprints, diggings, and burrows left by larger terrestrial mammals. Any mammals directly observed were recorded, and identification was as accurate as possible based on the field signs.

6.3.26    Bat surveys were conducted along the transect routes shortly after sunset using a bat detector to record echolocation calls. The relative abundance of the species encountered were estimated with reference to the baseline monitoring results, using a scale from one (species recorded within transect routes) to three (dominant species within transect routes), for comparison between baseline and current monitoring results. Mammal nomenclature followed Shek (2006).

6.3.27    Echolocation calls of bats were recorded using a bat detector, which listed possible bat species with similar call patterns and frequencies. The structure of the recorded echolocation calls was later analysed to identify species as accurately as possible. Due to the lack of literature on echolocation call structures, field identification of some bat species in Hong Kong is challenging, and some species could only be identified to the genus level or remain unidentified from the recordings.

6.3.28    Identification of bat species encountered in the surveys was made by considering the possible species suggested by the bat detector, their distribution in Hong Kong, previous records in the EIA Report and Baseline Monitoring Report, and the structure of the echolocation calls (including call structure, frequency, duration, and inter-pulse interval) with reference to relevant literature.

Herpetofauna (Amphibians and Reptiles)

6.3.29    Both daytime and nighttime amphibian surveys were conducted whenever possible following or during periods of rainfall, focusing on areas suitable for amphibians (e.g., forests, shrublands, grasslands, streams, ponds, marshes, etc.). Calling amphibians were recorded, supplemented by visual observations of eggs, tadpoles, adult frogs, and toads.

6.3.30    Active searches of appropriate microhabitats, such as stones, pond bunds, crevices, and leaf debris, was primarily conducted. Observations of exposed, basking, and foraging reptiles were also carried out. Nomenclature for amphibians and reptiles followed Chan et al. (2005) and Karsen et al. (1998), respectively.

Butterfly and Odonates

6.3.31    Butterflies and dragonflies observed along the transects were identified and counted. Special attention was given to their preferred habitats, such as watercourses, fishponds, and vegetated areas. Nomenclature and protection status of the species followed Lo et al. (2005) for butterflies and Tam et al. (2011) for dragonflies.

Monitoring Parameters

6.3.32    The monitoring parameters are as follows:

·       Species composition;

·       Abundance;

·       Distribution for fauna observed; and

·       Species of conservation importance would be specified.

Monitoring Location

6.3.33    According to the Updated EM&A Manual, the transect routes for monitoring of ecologically sensitive receivers should follow the following:

·       T1. Ma Tso Lung riparian zone and associated wetland habitats; green belt areas E1-8, D1-8 and G1-3 in KTN NDA; AGR zone C2-4 and C2-2 in KTN NDA, and area north of Ng Tung River;

·       T2. Fanling North Freshwater Service Reservoir

·       T3. Area west of Siu Hang San Tsuen Stream;

·       T4. South side of Fanling Highway and Castle Peak Road in the vicinity of Pak Shek Au;

·       T5. Area west and east of the southern limit of the FLN NDA work area; and

·       T6. Areas in the western part of KTN.

6.3.34    The above transects are shown in Figure 6.1 and Figure 6.2. Relevant transect to Works Contract ND/2024/01 is Transect T1 which covers areas of Ma Tso Lung riparian zone and associated wetland habitats, green belt areas E1-8, D1-8 and G1-3 in KTN NDA, AGR zone C2-4 and C2-2 in KTN NDA, and areas North of Ng Tung River; relevant transects to Works Contract ND/2024/02 are Transect T1 and T6, of which the latter covers areas to the west of the KTN NDA work area; relevant transect to Works Contract ND/2024/03 is Transect T4 which covers the south side of the Fanling Highway and Castle Peak Toad in the vicinity of Pak Shek Au; relevant transect to Works Contract ND/2024/06 is Transect T2 which covers areas of the Fanling North Freshwater Service Reservoir; Works Contract ND/2024/07 involves Transect T3 which covers the area west of Siu Hang San Tsuen stream; and Works Contract ND/2024/08 involves Transect T3 as well.

Monitoring Frequency

6.3.35    Monthly monitoring should be conducted for non-aquatic fauna, including terrestrial mammals, insects (butterflies and odonates), and herpetofauna. For this reporting month, monthly monitoring for non-aquatic fauna were conducted by both the First Phase ET (T1, T3, T4 and T6) and Remaining Phase ET (T2). Survey dates for each monitoring are shown in Table 6.7.

Table 6.7 Monitoring Programme for Non-aquatic Fauna Monitoring, April 2026

Responsible ET

Date

Transect(1)

First Phase ET

15 April 2026

T3, T4

21 April 2026

T1, T6

Remaining Phase ET

23, 27 April 2026

T2

Remarks:

(1)    Transect T1 is relevant to Works Contract ND/2024/01 and Works Contract ND/2024/02; Transect T2 is relevant to Works Contract ND/2024/06; Transect T3 is relevant to Works Contracts ND/2024/07 and ND/2024/08; Transect T4 is relevant to Works Contract ND/2024/03; Transect T6 is relevant to Works Contract ND/2024/02.



Monitoring Results

Terrestrial Mammals

6.3.36    A total of 4 species of terrestrial mammals (2 native and 2 introduced) were recorded along Transect T1. Short-nosed Fruit Bat and Japanese Pipistrelle are native species of conservation importance. 5 native bat species of conservation importance, namely Chinese Noctule, Japanese Pipistrelle, Least Pipistrelle, Lesser Yellow Bat and Lesser Bent-winged Bat, were recorded along Transect T2 for the reporting month. 1 species of native terrestrial mammal, namely the Short-nosed Fruit Bat, was recorded along Transect T3. The Bat is recognised as a species of conservation importance. A total of 5 species of terrestrial mammal species  (2 native and 3 introduced) were recorded along Transect T4, with Short-nosed Fruit Bat, Japanese Pipistrelle and Pallas’s Squirrel are of conservation importance. A total of 2 mammal species (1 native and 1 introduced) were recorded along Transect T6 for the reporting month, and either of them is of conservation importance. A complete species list is enclosed as Appendix 6.3.

Herpetofauna (Amphibians and Reptiles)

6.3.37    8 native herpetofauna species (6 amphibians and 2 reptiles) were recorded along Transect T1. All species are common and widespread natives. 8 native herpetofauna species (5 amphibians and 3 reptile species) and 1 introduced species were recorded along Transect T2, of which all are considered common and widespread locally. 3 native herpetofauna species (1 amphibians and 2 reptiles) were recorded along Transect T3 for the reporting month. All species are widespread and locally common.  A total of 7 native herpetofauna species (3 amphibians and 4 reptile species) were recorded along Transect T4, with no species of conservation importance noted. 5 native and widespread herpetofauna species (3 amphibians and 2 reptiles) were recorded along Transect T6. A complete species list is enclosed as Appendix 6.3.

Butterfly and Odonates

6.3.38    A total of 27 butterfly species were recorded along Transect T1, with 1 species (Small Cabbage White) is of conservation importance. 5 odonate species were recorded along Transect T1. All species recorded are considered as common natives. 9 butterfly species were recorded along Transect T2 for the reporting month, with 1 species, namely the Danaid Egg-fly, is of conservation importance. 2 odonate species, namely Common Blue Skimmer and Common Red Skimmer, were recorded during the monitoring for the reporting month. Both are common and widespread natives and none are of conservation importance. A total of 10 butterfly species were recorded along Transect T3, with 1 species (Yellow Rajah) recorded is of conservation importance. 5 odonate species were recorded along Transect T3. All species recorded are considered as common natives. 20 butterfly species were recorded along Transect T4 with 1 species of conservation importance (Swallowtail) was noted. 4 odonate species were recorded along Transect T4. All species recorded are considered as common natives.16 butterflies were recorded along Transect T6 for the reporting month, with 1 species (Small Cabbage White) is of conservation importance noted. 4 common species of odonate were recorded along Transect T6, with no species of conservation importance noted. A complete species list is enclosed as Appendix 6.3.

Summary of Monitoring Results

6.3.39    Monitoring for non-aquatic (terrestrial mammals, butterflies, dragonflies, and herpetofauna) taxa was conducted by both the First Phase and Remaining Phase ETs. Relevant results of the non-aquatic fauna monitoring conducted by the First Phase ET during this reporting month are detailed in Appendix 6.3a to Appendix 6.3d. Findings of surveys conducted by the Remaining Phase ET during this reporting month are detailed in Appendix 6.3e to Appendix 6.3h.

6.3.40    Tables 6.8 summarizes the monitoring results of Transect T1, T2, T3, T4 and T6 for this reporting month.

Table 6.8 Summary Table of Monitoring Results for Non-aquatic Fauna Relative to Action and Limit Levels, April 2026, Transect T1, T2, T3, T4 and T6

Monitoring Parameter

Result in
Reporting Month
(April 2026) (1)

Baseline Level in Corresponding Month (April 2020) (1)

Action Level(2)

Limit Level(3)

T1

Terrestrial Mammals

2

2

N/A

1

Herpetofauna

8

8

6

4

Odonates

5

6

4

3

Butterflies

27

10

7

5

T2

Terrestrial Mammals

5

0

N/A

N/A

Herpetofauna

8

1

N/A

N/A

Odonates

2

3

2

1

Butterflies

9

4

3

2

T3

Terrestrial Mammals

1

1

N/A

N/A

Herpetofauna

3

4

3

2

Odonates

5

7

5

4

Butterflies

10

4

3

2

T4

Terrestrial Mammals

2

1

N/A

N/A

Herpetofauna

7

4

3

2

Odonates

4

3

2

1

Butterflies

20

6

4

3

T6

Terrestrial Mammals

1

0

N/A

N/A

Herpetofauna

5

3

2

1

Odonates

4

5

4

3

Butterflies

16

5

4

3

Remarks:

(1)      Number of species (species richness) recorded; the results in the reporting month for terrestrial mammals, herpetofauna and odonates are calculated based on the number of native species recorded along the transects.

(2)      Exceedance of Action Level occurs when the monitoring result is lower than the Action Level.

(3)      Exceedance of Limit Level occurs when the monitoring result is lower than the Limit Level.

6.3.41    No exceedance in Action or Limit Level was recorded for the reporting month.

Details of the Influencing Factors

6.3.42    The details of the influencing factors were adopted from the observations of the First Phase ET. During the monitoring of measures to minimize disturbance to waterbirds in Long Valley and Sheung Yue River, anthropogenic activities such as excavation and other construction activities were observed near Long Valley.  It should also be noted that the Long Valley Nature Park has been opened to the public since 09 November 2024. Potential increase in people visiting the park may potentially impact the habitats in Long Valley and cause disturbances to the bird communities in this area. Construction works were also observed along Sheung Yue Riverr.

6.3.43    During the monitoring of measures to minimize disturbance to waterbirds in Ng Tung River, various anthropogenic activities were observed, such as construction works along Transect T2, recreational use of remote-control boats and toy helicopters in both Transects T1 and T2, and recreational fishing along these two transects.

Survey Summary

6.3.44    All ecological monitoring surveys for the reporting month have been carried out as scheduled, with no exceedance reported for the reporting month.

6.4          Man Kam To Egretry Monitoring

6.4.1       A pre-site clearance check of the Man Kam To Egretry (MKT Egretry) was undertaken on 13 February 2026 to investigate its status, extent, and location prior to the commencement of works within 100m of the egretry, pursuant to EM&A Manual Section 14.3.2.3.

6.4.2       Following the monitoring conducted in March, egretry location was checked on 15 April 2026 for the reporting month to identify and confirm the presence of any ardeid nests, covering the previous core extent and its split colonies, prior to the commencement of works activity within 100m of the egretry.

6.5          Event and Action Plan

6.5.1       Should non-compliance of the ecological monitoring criteria occur, actions in accordance with the Event and Action Plan in Appendix 6.4 shall be carried out.




7              Landscape and Visual

7.1          Audit Requirements

7.1.1       According to the approved EM&A manual and Updated EM&A Manual for the First Phase, site audits should be undertaken at least once every two weeks during the construction period, by the Environmental Team. Particularly, to check that the proposed landscape and visual mitigation measures are properly implemented and maintained as per their intended objectives. Mitigation measures recommended in the EIA Report as the audit requirements including, preservation of existing vegetation, transplanting of affected trees, compensatory tree planting, control of night-time lighting glare, erection of decorative screen hoarding and management of construction activities and facilities.

7.2          Results and Observations

7.2.1       Bi-weekly landscape and visual site audits were carried out by the ET during the reporting period. Inspections were carried out on 2, 16 and 28 April 2026 for ND/2024/01, 2, 17 and 28 April 2026 for ND/2024/02, 15 and 27 April 2026 for ND/2024/03, 10 and 24 April 2026 for ND/2024/04, 9 and 21 April 2026 for ND/2024/06, 9 and 23 April 2026 for ND/2024/07.  No particular observation was recorded in this reporting period.

7.3          Event and Action Plan

7.3.1       Should any non-compliance of the criteria occur, action in accordance with the Event and Action Plan in Appendix 7.1 shall be followed.




8              Land Contamination (Ambient Arsenic Monitoring)

8.1          Monitoring Requirements

8.1.1       According to the approved EM&A Manual and Updated EM&A Manual for the First Phase, an ambient arsenic monitoring is required to be conducted in KTN during the clean-up processes of arsenic containing soil and the construction phase.

8.1.2       The RSP concentration was measured by HVS equipped with PM10 selector (PM10 HVS) following the "Reference Method for the Determination of Particulate Matter as PM10 in the Atmosphere" Part 50 Chapter 1 Appendix J, Title 40 of the Code of Federal Regulations of the USEPA.

8.1.3       The Dust-laden air was drawn through PM10 HVS fitted with a conditioned pre-weighting filter paper, at a controlled rate. After sampling for 24-hour, the filter paper with retained PM10 particulates was collected and returned to the laboratory for drying in a desiccator followed by accurate weighting. 24-hour average RSP levels were calculated from the ratio of the mass of PM10 particulates retained on the filter paper to the total volume of air sampled.

8.1.4       The weighted filter paper was prepared for arsenic testing through a "Hot Acid Extraction Procedure". The extracted material was tested for arsenic by using Inductively Coupled Plasma/Mass Spectrometry (ICP/MS). The extraction and testing were referenced to the following methods:

·       Compendium Method 1O-3.1 Selection, Preparation and Extraction of Filter Material, Center for Environmental Research Information, Office of Research and Development, USEPA, June 1999; and Compendium Method 1O-3.5 determination of Metals in Ambient Particulate Matter using Inductively Coupled Plasma/Mass Spectrometry (ICP/MS., Center for Environmental Research Information, Office of Research and Development, USEPA, June 1999.

8.2          Monitoring Locations

8.2.1       Ambient arsenic monitoring was conducted at the monitoring station(s) under the Work Contract(s), as shown in Table 8.1 describes the location of the ambient arsenic monitoring station. The location of the ambient arsenic monitoring station is presented in Figure 8.1.

Table 8.1 Location of Ambient Arsenic Monitoring station

Monitoring Station(s)

Location(s)

Works Contract(s)

KTN-DMS-4A(1)(2)

Temporary Structure at Pak Shek Au

ND/2024/01

Remarks:

(1)    Monitoring at the original location of KTN-DMS-4 (originally proposed in the approved EM&A Manual) was denied as there was no electricity supply. An alternative location (KTN-DMS-4A) was proposed by First Phase ET.

(2)    The ambient arsenic monitoring was conducted by First Phase ET during the reporting period.

8.3          Monitoring Equipment

8.3.1       Table 8.2 summarises the equipment used in the ambient arsenic monitoring. Copies of the calibration certificates for ambient arsenic monitoring are shown in Appendix 8.1

Table 8.2 Ambient Arsenic Monitoring Equipment

Monitoring

Station

Equipment

Manufacturer

Model

No. of Equipment

KTN-DMS-4A(1)(2)

Calibrator

TISCH

TE-5025A

1

HVS Sampler (RSP)

TISCH

TE-6070X

1

Remarks:

(1)    Monitoring at the original location of KTN-DMS-4 (originally proposed in the approved EM&A Manual) was denied as there was no electricity supply. An alternative location (KTN-DMS-4A) was proposed by First Phase ET.

(2)    The ambient arsenic monitoring was conducted by First Phase ET during the reporting period.

8.4          Monitoring Parameters, Frequency and Duration

8.4.1       Table 8.3 summarises the monitoring parameters and frequencies of ambient arsenic during the clean-up processes of arsenic-containing soil and construction. The ambient arsenic monitoring schedule for the reporting month shown in Appendix 2.1.

Table 8.3 Impact Ambient Arsenic Monitoring Parameters, Frequency and Duration

Parameters

Frequency(1)

24-hour RSP (Ambient Arsenic)

Once/ 6 days

Remark:

1.      The ambient arsenic monitoring was conducted by First Phase ET during the reporting period.




8.5          Monitoring Methodology and QA/QC Procedure



Instrumentation

8.5.1       HVS (GMW PM10 (TE6070X)) complete with appropriate sampling inlets was employed for 24-hour RSP monitoring. The sampler was composed of a motor, a filter holder, a flow controller and a sampling inlet and its performance specification complied with that required by USEPA Standard Title 40, Code of Federation Regulations Chapter 1 (Part 50).

8.5.2       The following guidelines were adopted during the installation of HVS:

·       a horizontal platform with appropriate support to secure the samplers against gusty wind was provided;

·       no two samplers were placed less than 2 meters apart;

·       the distance between the sampler and an obstacle, such as buildings, was at least twice the height that the obstacle protrudes above the sampler;

·       a minimum of 2 meters of separation from walls, parapets and penthouses was required for rooftop samplers;

·       a minimum of 2 meters separation from any supporting structure, measured horizontally was required;

·       no furnace or incinerator flue was nearby;

·       airflow around the sampler was unrestricted;

·       the sampler was more than 20 meters from the dripline;

·       any wire fence and gate, to protect the sampler, were not cause any obstruction during monitoring;

·       permission was obtained to set up the samplers and to obtain access to the monitoring stations; and

·       a secured supply of electricity was needed to operate the samplers



Operating/analytical procedures for the operation of HVS



·         Prior to the commencement of the dust sampling, the flow rate of the high volume sampler was properly set (between 1.1 m3 /min. and 1.4 m3 /min.) in accordance with the manufacturer's instruction to within the range recommended in USEPA Standard Title 40, CFR Part 50;

·         The power supply was checked to ensure the sampler worked properly. On sampling, the sampler was operated for 5 minutes to establish thermal equilibrium before placing any filter media at the designated air monitoring station;

·         The filter holding frame was then removed by loosening the four nuts and a weighted and conditioned filter was carefully centered with the stamped number upwards, on a supporting screen;

·       The filter was aligned on the screen so that the gasket formed an airtight seal on the outer edges of the filter. The filter holding frame was then tightened to the filter holder with swing bolts. The applied pressure was sufficient to avoid air leakage at the edges;

·       The shelter lid was closed and secured with the aluminium strip;

·       The timer was then programmed. Information was recorded on the record sheet, which included the starting time, the weather condition and the filter number (the initial weight of the filter paper can be found out by using the filter number);

·       After sampling, the filter was removed and sent to the Wellab Ltd. for weighing. The elapsed time was also recorded; and

·       Before weighing, all filters were equilibrated in a conditioning environment for 24 hours. The conditioning environment temperature was between 25°C and 30°C and did not vary by more than ±3°C; the relative humidity (RH) was < 50% and did not vary by more than ±5%. A convenient working RH was 40%. Weighing results were further analysis of RSP concentrations collected by each filter.

8.6          Maintenance/Calibration

8.6.1       The following maintenance/calibration was required for the HVS:

·       The high volume motors and their accessories were properly maintained. Appropriate maintenance such as routine motor brushes replacement and electrical wiring checking were made to ensure that the equipment and necessary power supply were in good working condition; and

·       High volume samplers were calibrated at bi-monthly intervals using TE-5025A Calibration Kit throughout all stages of the ambient arsenic monitoring.

8.7          Laboratory Measurement / Analysis

8.7.1       Quartz filters of size 8” x 10” were labelled before sampling. A HOKLAS accredited laboratory, Wellab Ltd., was responsible for the preparation of 24-hour conditioned and pre-weighed filter papers for the monitoring team. The balance for weighting filter paper was regularly calibrated against a traceable standard.

8.7.2       All filters, which were prepared and equilibrated in the conditioning environment for 24 hours before weighing. The conditioning environment temperature was around 25 °C and not variable by more than ±3 °C; the relative humidity (RH) was < 50% and not variable by more than ±5%. A convenient working RH was 40%.

8.7.3       Wellab Ltd. (HOKLAS Registration No. HOKLAS083), was responsible for the extraction and testing procedure for Arsenic and comprehensive quality assurance and quality control programmes were conducted.





8.8          Result and Observations

8.8.1       The ambient arsenic monitoring results are summarised in Table 8.4.

Table 8.4 Result Summary Against Action and Limit Levels for 24-hour RSP Monitoring Results (Ambient Arsenic)

Contract No.

Monitoring

Date

Monitoring

Station

Concentration

(ƞg/m3)

AL

(ƞg/m3)

LL

(ƞg/m3)

ND/2024/01

6/4/2026

KTN-DMS4A*

3.76

9.36

11.7

10/4/2026

4.76

16/4/2026

3.47

22/4/2026

4.63

28/4/2026

5.46

Remark:

* The 24-hour RSP monitoring for ambient arsenic was conducted by First Phase ET during the reporting period.

8.8.2       All ambient arsenic monitoring was conducted as scheduled in the reporting month. During the reporting month, 1,123.58 m3 of arsenic soil transported to soil treatment plant and treated. No AL or LL exceedances were recorded.

8.9          Event and Action Plan

8.9.1       Should any non-compliance of the criteria occur, actions in accordance with the Event/Action Plan in Appendix 8.2 shall be carried out.






9              Landfill Gas Monitoring

9.1          Monitoring Requirements

9.1.1       In accordance with the updated EM&A Manual, monitoring of landfill gas (LFG) is required for the construction works within the 250m Landfill Consultation Zone of Ma Tso Lung (MTLL, close to KTN NDA) during the construction phase. This section presents the results of landfill gas measurements performed by the Contractor.

9.1.2       The MTLL is situated in the vicinity of the KTN NDA. A portion of the development falls within the 250m Landfill Consultation Zone of MTLL.

9.2          Monitoring Parameters and Frequency

9.2.1       Monitoring parameters for Landfill gas monitoring include Methane, Carbon dioxide and Oxygen.

9.2.2       Monitoring According to the mitigation measures of the updated EM&A Manual, measurements of the following frequencies should be carried out according to the monitoring requirements and procedures specified in Paragraphs 8.23 to 8.28 of EPD's Guidance Note, “LANDFILL GAS HAZARD ASSESSMENT GUIDANCE NOTE”.

9.2.3       The frequency of monitoring of LFG was made reference to the updated EM&A Manual - Monitoring of any LFG which may be migrated to the site should be undertaken during construction of the infrastructure and the development within the Consultation Zone and within MTLL when the works involve confined spaces. Routine gas monitoring should be undertaken during groundwork construction and in all excavations. Monthly gas monitoring should also be conducted for set up on site such as offices, stores etc.

9.3          Monitoring Locations

9.3.1       As confirmed by the Supervisor Team, no ground disturbance works were carried out in the work area within 250m Landfill Consultation Zone of Ma Tso Lung Landfill including construction of the infrastructure, development works, excavation works and works involve confined spaces. Routine gas monitoring should be undertaken during groundwork construction and in all excavations. Thus, in this reporting month, the area is not required to be monitored for landfill gas are shown below.



Ø     Excavation Locations:                N/A

Ø     Manholes and Chambers:          N/A

Ø     Relocation of monitoring wells:   N/A

Ø     Any other Confined Spaces:       N/A

9.4          Result and Observations

9.4.1       As confirmed by the Supervisor Team, no ground disturbance works were carried out in the work area within 250m Landfill Consultation Zone of Ma Tso Lung Landfill including construction of the infrastructure, development works, excavation works and works involve confined spaces. Routine gas monitoring should be undertaken during groundwork construction and in all excavations. Therefore, no landfill gas monitoring was carried out.




10          Built Heritage Monitoring

10.1      Monitoring Requirements

10.1.1    In accordance with the updated EM&A Manual, baseline condition survey and baseline vibration impact assessment shall be conducted for identified built heritage prior to the commencement of construction works. Baseline condition survey and baseline vibration impact assessment shall be conducted by a qualified building surveyor or qualified structural engineer to define the vibration limit (a vibration limit at 7.5mm/s and 15mm/s could be adopted for graded historical buildings and historical buildings respectively) and to evaluate if construction vibration monitoring and structural strengthening measures are required during construction phase to ensure the construction performance meets the vibration standard stated in the EIA report.

10.1.2    According to the condition survey report from cultural heritage condition survey for ND/2024/01 under EP-468/2013A and for ND/2024/03 under EP-465/2013A and EP-466/2013A a vibration monitoring plan was proposed for the surveyed cultural heritage, the Alert/Alarm/Action (3As) levels was adopted as recommended by the Antiquities and Monuments Office (AMO). This section presents the results of built heritage monitoring performed by the Contractor according to the proposed monitoring plan in baseline condition survey report.

10.2      Monitoring Location

10.2.1    In the reporting month, construction vibration monitoring was conducted for built heritage features at G203 when vibration-induced site activities (e.g. excavation, sheet piling, etc.) were conducted within assessment area of the construction works. The location of the construction vibration monitoring stations was summarised in Table 10.1 and shown in Appendix 10.1.

Table 10.1 Location of Construction Vibration Monitoring

EP No.

Contact No.

Monitoring Station(s)

Nature of Cultural Heritage

Location(s)

EP-465/2013A, EP-466/2013A and EP-467/2013A

ND/2024/03

G203*

Enchi Lodge

Castle Peak Road – Kwu Tung

Remark:

* Since the access right to the original vibration monitoring points at Enchi Lodge was formally declined, alternative monitoring station were proposed within the construction site area of ND/2024/03 and accepted by Antiquities and Monuments Office (AMO).

10.3      Monitoring Parameters and Frequency

10.3.1    Table 10.2 summarises the vibration monitoring plan for surveyed cultural heritage under the Works Contracts. Vibration monitoring was conducted for surveyed built heritage when vibration-induced site activities (e.g. excavation, sheet piling, etc.)  were conducted within the assessment area of construction works.




Table 10.2 Vibration Monitoring Plan

EP No.

Contact No.

Monitoring Station(s)*

Distance with Construction Works

Monitoring Plan

EP-465/2013A, EP-466/2013A and EP-467/2013A

ND/2024/03

G203

Within 50m



Within 75m



Within 100m

Daily assessment is required

Bi-daily assessment is required

Weekly assessment is required

Remark:

*  Baseline condition survey was conducted for built heritage features at G302, G303, G308, KT26, KT53, KT65 and HKT03 for ND/2024/01 under EP-468/2013/A, G102, G202, G203, G303 and HKT03 for ND/2024/03 under EP-465-2013A and EP-466/2013A. As G102, G202, G203, G302, G303, G308, HKT03, KT26, KT 53 and KT65 were not within the assessment area of the related construction work, no construction vibration monitoring was conducted for the built heritage in the reporting month.

10.3.2    The construction vibration monitoring is planned to be conducted throughout each event of the vibration-induced site activities (e.g. excavation, sheet piling, etc.) on daily / bi-daily / weekly basis. The effect of ground-borne vibration from piling works on the surveyed built heritage was assessed by the maximum peak particle velocity (ppv), which was obtained from the maximum value of measurement of all vibration-induced site activities (e.g. excavation, sheet piling, etc.).

10.4      Monitoring Equipment

10.4.1    Copies of calibration certificates of the monitoring equipment employed by the Contractor of the construction vibration monitoring are attached in Appendix 10.2.

10.5      Result and Observations

10.5.1    In the reporting month, construction vibration monitoring was carried out by the Contractor for the built heritage features at G203 on a daily basis when vibration-induced site activities (e.g. excavation, sheet piling, etc.) were conducted within 50m of the construction work. No Limit Level exceedance for construction vibration monitoring was recorded in the reporting month. The monitoring results are provided in Appendix 10.3.

10.6      Event and Action Plan

10.6.1    Table 10.3 summarises the vibration limits for construction vibration monitoring for surveyed cultural heritage under ND/2024/01 and ND/2024/03, based on the Alert/Alarm/Action (3As) levels as recommended by the AMO.

Table 10.3 Levels of Alert, Alarm and Actions for Tilting, Vibration and Settlement

Monitoring Types

Alert

Alarm

Acton

Tilting

1:2000

1:1500

1:1000

Settlement

6 mm

8 mm

10 mm

Ground Settlement

15 mm

20 mm

25 mm

Vibration (PPV)

5 mm/s

6 mm/s

7.5 mm/s

10.6.2    If any exceedance of limits is found or damage to either structural or non-structural elements of the historic buildings is identified, the construction works should be stopped immediately and structural engineers’ advice should be sought for any remedial work.



11          Environmental Site Inspection and Audit

11.1      Implementation Status of Environmental Mitigation Measures

11.1.1    Site inspections were carried out on a weekly basis to monitor the implementation of proper environmental pollution control and mitigation measures under the Contract.  In the reporting period, Works Contract No. ND/2024/01 on 2, 9, 16, 21 and 28 April 2026. For Works Contact No. ND/2024/02 were carried out on 2 ,9, 17, 21, 28 April 2026. For Works Contact No. ND/2024/03 were carried out on 8, 15, 20 and 27 April 2026. For Works Contact No. ND/2024/04 were carried out on 2, 10, 17, 24 and 30 April 2026. For Works Contact No. ND/2024/06 were carried out on 9, 15, 21 and 28 April 2026. For Works Contract No. ND/2024/07 were carried out on 2, 9, 16, 23 and 30 April 2026.

11.1.2    Some major environmental deficiencies were observed during weekly site inspection in the report period and some general reminders regarding environmental aspects were given to the Contractor. Key observations and reminders observed during the site inspections at Works Contract No. ND/2024/01, ND/2024/02, ND/2024/03, ND/2024/04, ND/2024/06 and ND/2024/07 in the reporting period are summarized in Table 11.1.

Table 11.1 Site Observations at Works Contract No. ND/2024/01, ND/2024/02, ND/2024/03, ND/2024/04, ND/2024/06 and ND/2024/07 during the Reporting Period

Works Contracts

Inspection Date

Key Observations/ Reminders

Follow-up Action

ND/2024/01

2 April 2026

Observation:



Nil





Nil

Reminder:



Nil

Nil

9 April 2026

Observation:



Nil





Nil

Reminder:



Nil

Nil

16 April 2026

Observation:



Nil





Nil

Reminder:



Nil

Nil

21 April 2026

Observation:



1. At Portion 10, 11 and 23, the chemical containers on site should be placed on drip trays, or to be removed properly if they are emptied.



2. At Portion 40, the dirt on public road should be cleaned, and the entrance of the site should be cleaned regularly.





1. The concerned chemical containers were removed.




2. The dirt on public road was cleaned.

Reminder:



1. At Portion 10, 11 and 23, the dusty stockpiles on site are reminded to be properly covered after work.

Nil

28 April 2026

Observation:



1. At Portion 40, all dirt and soil along the site boundary and on the adjacent public road shall be properly cleared.





1.The dirt and soil along the site boundary and on the public road were cleared.

Reminder:



Nil

Nil

ND/2024/02

2 April 2026

Observation:



Nil

Nil

Reminder:



Nil

Nil

9 April 2026

Observation:



Nil

Nil

Reminder:



Nil

Nil

17 April 2026

Observation:



Nil

Nil

Reminder:



1. At Community Sports (Area J), the NRMM label with faded colour on the PME is reminded to be replaced.



2. At Area D, improvements can be made to the cement batching and mixing shelter.

Nil

21 April 2026

Observation:



Nil

Nil

Reminder:



Nil

Nil

28 April 2026

Observation:



1. At Portion 2, drip tray should be provided for the chemical container and the generator on site.

1. The concerned chemical container was removed, and drip tray was provided to generator.

Reminder:



1. At Portion 2, the NRMM labels that are damaged or with faded colour should be replaced on the PME.

Nil

ND/2024/03

8 April 2026

Observation:



Nil





Nil

Reminder:



Nil

Nil

15 April 2026

Observation:



Nil





Nil

Reminder:



1. The contractor was reminded that dust and silt materials should be removed in temporary drainage near Wai Kee.



2. Water spraying should be applied to reduce dust emission near site office.

3.
Stagnant water shall be pumped out near Pile Cap PB4 and PC4, and it was reminded to review the flood capacity of the area considering the upcoming rainy season.

Nil

20 April 2026

Observation:



Nil

Nil

Reminder:



1. The Contractor was reminded to pump stagnant water to wastewater treatment facilities at Tsung Pak Long after raining. The Contractor was also reminded to regularly inspect and maintain wastewater treatment facilities to ensure proper and efficient operation especially under rainy seasons.



2. The Contractor was reminded to provide containers for temporary storage of general waste at Pile Cap PB4 and PC4.

Nil

27 April 2026

Observation:



Nil

Nil

Reminder:



1. Stagnant water inside the drip tray was observed at M526. The contractor was reminded to clear the stagnant water regularly after raining.



2. The contractor was reminded to ensure wastewater treatment facility is properly set up for treating site runoff at M526.

Nil

ND/2024/04

2 April 2026

Observation:



Nil





Nil

Reminder:



1. At SE 03, the contractor was reminded to regularly clear stagnant water.

Nil

10 April 2026

Observation:



1. The contractor shall regularly remove stagnant water from work area at SE 03.





1. The stagnant water was removed from work area.

Reminder:



Nil

Nil

17 April 2026

Observation:



1. The contractor shall ensure the NRMM label is presented on necessary machinery at Portion 3.





1. The NRMM has been presented on the concerned machinery.

Reminder:



Nil

Nil

24 April 2026

Observation:



Nil

Nil

Reminder:



Nil

Nil

30 April 2026

Observation:



1. The Contractor shall ensure proper measures to prevent site runoff from going out of site boundaries at Portion 1.

1.The stagnant water near site entrance was cleaned.

Reminder:



Nil

Nil

ND/2024/06

9 April 2026

Observation:



1. Sandbags/ Bunding should be provided to prevent any sand and silt washing into the nearby watercourse at Portion D.



2. Drip trays should be provided for storing chemicals at Pit B and Pit C.





1. Sandbags were provided.







2. The concern chemicals were removed.

Reminder:



1. The Contractor was reminded to replace the broken acoustic mat on the breaker head at Area C.



2. The Contractor was reminded to provide containers for temporary storage of general waste at Portion D.



3. The Contractor was reminded to properly fence off for tree protection during construction at Pit B.

Nil

15 April 2026

Observation:



1. The chemical containers should be placed on a drip tray at Area C.





1. The concerned chemical container was removed.

Reminder:



1. The Contractor was reminded to cover the stockpile of dusty materials by impervious sheeting after works at Pit B and Pit C.

Nil

21 April 2026

Observation:



1. NRMM label should be displayed on the machinery equipment at Pit B.





1. The NRMM label was displayed on the machinery equipment.

Reminder:



1. The Contractor was reminded to cover dusty stockpiles with tarpaulin for dust suppression at Area C and Pit C.



2. The Contractor was reminded to wrapped acoustic mat on the breaker heads at Area C.



3. Stagnant water inside the drip tray was observed at Pit C. The contractor was reminded to clear the stagnant water regularly after raining.

Nil

28 April 2026

Observation:


Nil

Nil

Reminder:


Nil

Nil

ND/2024/07

2 April 2026

Observation:



1. Sand bags or bundings should be provided to prevent any washing of sand and silt into the drainage system at Road L2.



2. Chemical container should be properly placed in drip tray at FB-5.



3. NRMM label should be displayed at Area E.





1. Sand bags had been provided at Road L2.



2. The unused chemical container was removed.



3. The NRMM label was displayed on the generator.

Reminder:



Nil

Nil

9 April 2026

Observation:



Nil





Nil

Reminder:


Nil

Nil

16 April 2026

Observation:


Nil

Nil

Reminder:


Nil

Nil

23 April 2026

Observation:


Nil

Nil

Reminder:


Nil

Nil

30 April 2026

Observation:


Nil

Nil

Reminder:


Nil

Nil

11.1.3    According to the EIA Study Report, Environmental Permit, contract documents and Updated EM&A Manual, the mitigation measures detailed in the documents should be implemented as much as practical during the reporting period. An updated implementation status of environmental mitigation measures is provided in Appendix 1.3. The photographic records of measures as stipulated in EPs to mitigate ecological impacts in the reporting month are presented in Table 11.2.





Table 11.2 Photographic Records and Implementation Status of Measures for Ecological Impacts

Works Contracts

EP No.

Photographic Record

Implementation Status

ND/2024/01

EP-467/2013/A (Condition 2.9)



To minimise adverse impacts on habitats of ecological importance in the vicinity of the Project, 2m high solid dull green site barrier fences shall be erected around all active works areas.

^

EP-468/2013/A

(Condition 2.11)

ND/2024/03

EP-465/2013/A

(Condition 2.9)





To minimise adverse impacts on habitats of ecological importance in the vicinity of the Project, 2m high solid dull green site barrier fences shall be erected around all active works areas.

^

EP-466/2013/A

(Condition 2.9)

EP-467/2013/A

(Condition 2.11)

Implementation status:

^ Mitigation measure was fully implemented

* Observation / reminder was made during site audit but improved / rectified by the contractor

# Observation / reminder was made during site audit but not yet improved / rectified by the contractor

X Non-compliance of mitigation measure

•  Non-compliance but rectified by the contractor



N/A Not Applicable at this stage as no such site activities were conducted in the reporting period





12          Summary of Monitoring Exceedance, Complaints, Notification of Summons and Prosecutions

12.1      Summary of Exceedance

12.1.1    No Action Level or Limit Level exceedance was recorded for air quality monitoring in the reporting period.

12.1.2    Three Action Level exceedances for construction noise were recorded during the reporting month, corresponding to three noise-related complaints received. No Limit Level exceedance was recorded for construction noise monitoring in the reporting period.

12.1.3    No Action Level or Limit Level exceedance was recorded for ambient arsenic monitoring in the reporting period.

12.1.4    No Action Level or Limit Level exceedance was recorded for ecological monitoring in the reporting period.

12.1.5    No Action Level or Limit Level exceedance was recorded for built heritage monitoring (vibration monitoring) in the reporting period.

12.2      Summary of Environmental Non-Compliance

12.2.1    No environmental non-compliance was recorded in the reporting period.

12.3      Summary of Environmental Complaint

12.3.1    Total of 5 complaints were received during the reporting period.

12.3.2    The first environmental complaint was related to construction dust and construction waste generated from FLN NDA construction sites, particularly at Ma Sik Road on 8 April 2026 under works contract ND/2024/07. The complaint was received by EPD on 8 April 2026 and referred to CEDD, ET and IEC on 15 April 2026. The complaint case has been investigated by the Contractor and ET, and the investigation was closed out on 22 April 2026. The investigation findings indicate that there was no non-compliance by the contractor.

12.3.3    The second environmental complaint was related to construction noise generated from FLN NDA construction sites, particularly at Po Shek Wu Road North Bound near Tai Tau Leng Village Vehicular Access on 22 April 2026 under works contract ND/2024/04. The complaint was received by 1823 on 22 April 2026 and referred to CEDD, ET and IEC on 24 April 2026. The complaint case has been investigated by the Contractor and ET, and the investigation was closed out on 03 May 2026. The investigation findings indicate no non-compliance on conditions stipulated on the valid Construction Noise Permit (CNP).

12.3.4    The third environmental complaint was related to construction noise generated from FLN NDA construction sites, particularly at Po Shek Wu Road North Bound near Tai Tau Leng Village Vehicular Access on 22 April 2026 under works contract ND/2024/04. The complaint was received by 1823 on 22 April 2026 and referred to CEDD, ET and IEC on 24 April 2026. The complaint case has been investigated by the Contractor and ET, and the investigation was closed out on 03 May 2026. The investigation findings indicate no non-compliance on conditions stipulated on the valid Construction Noise Permit (CNP).

12.3.5    The fourth environmental complaint was related to construction dust and noise generated from KTN construction sites, particularly at Kwu Tung Yin Liu on 28 April 2026 under works contract ND/2024/03. The complaint was received by EPD on 28 April 2026 and referred to CEDD, ET and IEC on 28 April 2026. The complaint case has been investigated by the Contractor and ET, and the investigation was closed out on 11 May 2026.  The investigation findings indicate that the complaint was not project related.

12.3.6    The fifth complaint was related to sand and muddy water deposited on the carriageway caused by KTN construction sites, particularly at Castle Peak Road between Sheung Pak Nai Sewage Pumping Station and Pak Sau Road on 25 April 2026 under works contract ND/2024/03. The complaint was received by EPD on 25 April 2026 and referred to CEDD, ET and IEC on 29 April 2026. The complaint case has been investigated by the Contractor and ET, and the investigation was closed out on 11 May 2026. The investigation findings indicate that there was no non-compliance by the contractor.

12.3.7     The details of the complaints and investigation results are shown in Appendix 12.1.

12.4      Summary of Environmental Summon and Successful Prosecution

12.4.1    There was no successful environmental prosecution or notification of summons received since the Project commencement. The summary of environmental summon and successful prosecution is presented in Appendix 12.1.






13          Future Key Issues

13.1      Works and Potential Environmental Issues in the next Reporting Period

13.1.1    The upcoming construction works programme, and the construction works area of the Project are presented in Appendix 1.1. Works to be undertaken in the next reporting period are summarized below:

Works Contract No. ND/2024/01:

·  All Site Resumption Area(s)

1.   Tree survey

2.   Site Clearance

·  Portion III (3), IV (4), V (5) and XXXV (35)

1.   Site Formation

·  Portion VIII (8) , XVI (16), XXXII (31) and LVIII (58)

1.     Site Clearance & Demolition

·  Portion XVIII (18), XXXVIII (38)

1.     Excavation works

2.     Construction of CHC Box Culvert

·  Portion XI (11), XXIII (23)

1.     Formwork Erection, Rebar Fixing, Concreting Works

2.     Erection of Substructure of Metropolis Community Liaison and Visitor Centre

·  Portion XL (40)

1.   Retaining Wall Construction

2.   Drainages System Construction

3.   ELS work

·  Portion LIX (59)

1.   Treatment of High Arsenic-Containing Soil (HAS)

2.   Erection of Shredding Facility

·  Portion XVII (17), XVII (18), XXI (21), XXXIV (34), XXXV (35), XLI (41), XLII (42)

1.   Excavation Works

2.   Drainage Pipe Installation

3.   ELS Works

·  Portion XXV (25), XXVII (27), XXXIII (33), XLII (42) and XLIV (44)

1.   Site Clearance

2.   Site Formation

3.   Construction of Box Culvert



Works Contract No. ND/2024/02:

1.   Site clearance in Area A, B, C, D, T, L

2.   Site formation works in Area D

3.   Temporary storage fill bank in Kwu Tung Grass Soccer Pitch

4.   Demolition works for Community Sports in Area J

5.   Ground Investigation Works in Area B & L

6.   Asbestos Removal Works in Area C



Works Contract No. ND/2024/03:

        Fanling Highway & Castle Peak Road area



·  Pak Sau Road – Po Lau Road

1.   Tree Works

2.   Relocation/Reprovision/Removal of Existing TCSS, Fire Hydrant, Signage & Streetlighting

·  Po Lau Road – Sheung Yue River

1.   Asbestos Removal Works at Portion IX

2.   Box Culvert Bay 37 – Bay 42 ELS

·  TTA Stage 1 Works

1.   Tree Works

2.   Removal or relocation of directly impacted Shrine/historical building at HKT08 & KT72

3.   Demolish of Central Divider & Barrier along FL Highway E/B

New Tsung Pak Long Road



·  Box culvert Bay 10 to 12, 14 to 16 Drainage/Watermains

1.   Drainage, Sewerage & Watermain with Backfilling at Box Culvert Bay 15 & 16

2.   Box Culvert Bay 10-13 & 14 ELS

3.   Removal of ELS and Temp Road Diversion

·  Box culvert Bay 17 to 19 & Drainage/Watermains

1.   Box Culvert Bay 17 to 19 ELS, Base Slab, Wall and Top Slab

·  TTA Stage 1B

1.     Box Culvert Bay 3, 5 to 7, 7A ELS

2.   Box Culvert Base Slab

·  Retaining Wall RW05A

1.     RW05A ELS

2.   Base Slab and Wall

·  Kwu Tung Road Bridge

1.     Site Clearance and Tree Works

2.   Site formation and cutback the existing slope

3.   Foundation & Piling

·  Works Areas – WA1, WA2, WA3, WA4 & WA5

1.     Temporary Drainage

2.   Asbestos removal

Fanling Highway Cross River Bridge (along Sheung Yue River)



·  Portion XI – East Abutment & pier foundation (No works at wet season between 1 Apr 2026 and 31 Oct 2026)

1.     Trial Pits for UUs

2.   Piling Works

·  Road L3 Viaduct

1.     Piling Works

2.   Pile Cap L3A-02

Kwu Tung Interchange Foundation & Substructure



·  Bridge B1 & C1

1.     Piling Works

2.   ELS

·  Bridge B2 & C2

1.     Piling Work

·  Footbridges No. 4 at TTA Stage 1

1.     Ground Investigation

2.   Underground Utilities Works

3.   Piling

·  Footbridges No. 5 at TTA Stage 2

1.     Predrilling

·  Widening of Existing Bridge No.N526

1.     Tree Works

2.   Pilling



Works Contract No. ND/2024/04:

1.   Site Clearance

2.   Site Establishment

3.   Tree Felling

4.   Trial Pit

5.   Existing Sewage Diversion

6.   Haul Road Construction

7.   Bored Piling

8.   ELS Construction

9.   Slope Works

10.Road Diversion Works

11.Demolition of Existing Structures



Works Contract No. ND/2024/06:

·  Portion A

1.   Excavation to +84 mPD of Portion A

2.   Carry of Soil Nail of Portion A

·  Portion C, D, E & F

1.   Trench and Watermans Laying Works

·  Area N

1.   Jacking Pit Excavation

·  Pre-boring of Pit B & C



Works Contract No. ND/2024/07:

1.     Site Clearance

2.   Site Formation

3.   Ground Investigation

4.   Pre-bored Socketed H Pile Construction

5.   Bridge Construction

6.   Bridge Deck Connection (Footbridge FB5)

7.   Lift Tower Construction

8.   Sump Pit Construction

9.   ABWF Works

10.  Drainage Construction

11.  Improvement of Junction

12.  Road Construction

13.  Temporary Road Construction

14.  Open Landscaping Works

15.  Tree Felling & Transplantation

16.  Asbestos Containing Materials Survey & Removal

17.  Land Contamination (Environmental Ground Investigation)

18.  Internal Movement, Importation & Exportation of C&D materials

19.  Sewerage Construction

20.   Old Shrine Removal and New Shrine Construction

21.   Storm pipe Construction

22.   Box Culvert Construction

23.  Temporary Drainage Diversion

24.   Rebar yard

25.  Storage Yard for Concrete Pipe



Works Contract No. ND/2024/05 and No. ND/2024/08:

1.     The construction work has not commenced in the reporting month.

13.1.2    Potential environmental impacts arising from the above construction activities are mainly associated with construction noise impact, water quality impact, ecological impact, waste management, and landscape and visual.

13.2      Recommendation

13.2.1    The key environmental mitigation measures for the Project in the coming reporting period expected to be associated with the construction activities include:

Dust



        Regular watering to reduce dust emissions from exposed site surface;

        Stockpile of dusty materials shall be covered entirely by impervious sheeting;

        Provide vehicles washing facilities at all site exits to wash away any dusty materials from vehicle body;

        NRMM Labels should be displayed on the applicable equipment on site by the Contractor;

        Provision of water sprinklers along the haul road for dust suppression.



Noise



        Only well-maintained plant should be operated on-site, and plant should be maintained regularly during the construction programme; and

        Quality Powered Mechanical Equipment (QPME) should be adopted as far as possible.



Water Quality



        No effluent discharge would be allowed before acquired the effluent discharge license;

        Surface run-off from construction sites should be discharged into dedicated discharge point via adequately designed sand/ silt removal facilities;

        Channels/ earth bunds/ sandbags barriers should be provided on site to properly direct stormwater to silt removal facilities;

        Silt removal facilities, channels and manholes should be maintained, and the deposited silt and grit should be removed regularly;

        Open stockpiles of construction materials on sites should be covered with tarpaulin or similar fabric during rainstorms; and

        Perimeter channels should be provided on site boundaries where necessary to intercept stormwater run-off from outside the site so that it will not wash across the site.



Waste Management



        Provision of sufficient waste disposal points and regular collection of waste;

        Regular cleaning and maintenance programme for drainage system; and

        Chemical containers shall be stored with drip tray underneath.



Landscape and Visual



        Construction activities shall be carefully designed to minimize impact on existing retained trees.



Land Contamination



        Stockpiling site(s) should be lined with impermeable sheeting and bunded. Stockpiles should be properly covered by impermeable sheeting to reduce dust emission during dry season or contaminated run-off during rainy season. Watering should be avoided on stockpiles of soil to minimise runoff.



Landfill Gas Hazard

        “No Smoking” and “No Naked Flame” notices in Chinese and English should be posted prominently around the construction site.



Ecology



        Properly erect and maintain 2m high solid barriers for protection.

        An individual of orchid Eulophia cernua was found growing underneath the pipeline adjacent to the access road leading to the summit of the Table Hill Freshwater Service Reservoir for Contract No. ND/2024/06. The species of conservation importance should be fenced off for protection to minimise the potential impacts aroused from nearby construction activities as far as possible.

13.2.2    The tentative impact monitoring schedule for the next reporting period is shown in the Appendix 13.1. The regular impact monitoring will be conducted at the same monitoring locations in the next reporting period.



14          Conclusions

14.1      Conclusion

14.1.1    This is the 16th Monthly EM&A Report summarizing the findings of EM&A works at Works Contract No. ND/2024/01, Works Contract No. ND/2024/02, Works Contract No. ND/2024/03, Works Contract No. ND/2024/04, Works Contract No. ND/2024/06 and Works Contract No. ND/2024/07 during the reporting month, this report documents the findings of EM&A works at Works Contract No.  ND/2024/01, Works Contract No. ND/2024/02, Works Contract No. ND/2024/03, Works Contract No.  ND/2024/04, Works Contract No. ND/2024/06 and Works Contract No. ND/2024/07 under the Project during the reporting period only. No construction works occurred in the remaining contracts during the reporting period for Works Contract ND/2024/05 and ND/2024/08.

14.1.2    All air quality monitoring was conducted as scheduled in the report period. No Action Level or Limit Level exceedance was recorded for air quality monitoring in the reporting period.

14.1.3    All construction noise monitoring was conducted as scheduled in the report period. Three Action Level exceedances for construction noise were recorded during the reporting month, corresponding to three noise-related complaints received. No Limit Level exceedance was recorded for construction noise monitoring in the reporting period.

14.1.4    All ambient arsenic monitoring was conducted as scheduled in the reporting period.  No Action or Limit Level exceedance was recorded during ambient arsenic monitoring in the reporting period.

14.1.5    All ecological monitoring was conducted as scheduled in the reporting period. No Action or Limit Level exceedance was recorded during ecological monitoring in the reporting period.

14.1.6    No exceedance of limits was recorded for built heritage monitoring (vibration monitoring) in the reporting period.

14.1.7    Environmental site inspections were conducted at Works Contract No. ND/2024/01 on 2, 9, 16, 21 and 28 April 2026. For Works Contact No. ND/2024/02 were carried out on 2 ,9, 17, 21, 28 April 2026. For Works Contact No. ND/2024/03 were carried out on 8, 15, 20 and 27 April 2026. For Works Contact No. ND/2024/04 were carried out on 2, 10, 17, 24 and 30 April 2026. For Works Contact No. ND/2024/06 were carried out on 9, 15, 21 and 28 April 2026. For Works Contract No. ND/2024/07 were carried out on 2, 9, 16, 23 and 30 April 2026.

14.1.8    No notification of summons and prosecution was received in the reporting period.

14.1.9    The ET will keep track on the construction works to confirm compliance of environmental requirements and the proper implementation of all necessary mitigation measures.

14.1.10 No change to the EM&A programme was made in this reporting period.

14.2      Comments/ Recommendations

14.2.1    The proposed mitigation measures were properly implemented and were considered effective and efficient in pollution control.
